Apologies, but I'm trying to understand why you think the capacity is not sufficient with the current 2 vehicle trains.

Line 5 capacity models clearly state that the highest capacity required is around 5,500 pphpd at 2031. There isn't any reason to suspect that this number is incorrect. 5,500 is also almost triple what the current 34 bus carries on Eglinton. In any case theoretical maximum capacity with the current 2 car trains is around 10,000 pphpd, almost double the expected demand.

The easiest comparison is the eastern portion of Line 2. Line 2 has a theoretical maximum of around 23,000 pphpd and is close to hitting this maximum during the morning rush. Line 2 has been operating for over 50 years with all the N-S feeder buses dropping passengers at it's station and yet not as busy as the Yonge side of Line 1. Are you under the impression that Line 5 will be similar to this shortly after opening?

You mention Canada Line being under estimated on usage, but do you have any Toronto based rapid transit projects with under estimated demand? Sheppard Subway, TYSSE, etc?
The maximum theoretical capacity with the current 2 car trains is about 5,500 pphpd, and the maximum possible operable service is something like 7,600. These are the numbers used for the service levels. The idea of being able to reliably stuff 200, let alone 250, people into one LRV and operate normally is just not compatible with the reality.
Moreover, the ECLRT is a lot faster than the 34 and even more so the 32. Being so fast, it'll be a magnet for traffic.

Also, wouldn't Sarkaria (Transportation) be there for a Line 5 (or 6) opening announcement ? Surma is infrastructure

Last edited:
The maximum theoretical capacity with the current 2 car trains is about 5,500 pphpd, and the maximum possible operable service is something like 7,600. These are the numbers used for the service levels. The idea of being able to reliably stuff 200, let alone 250, people into one LRV and operate normally is just not compatible with the reality.
Moreover, the ECLRT is a lot faster than the 34 and even more so the 32. Being so fast, it'll be a magnet for traffic.

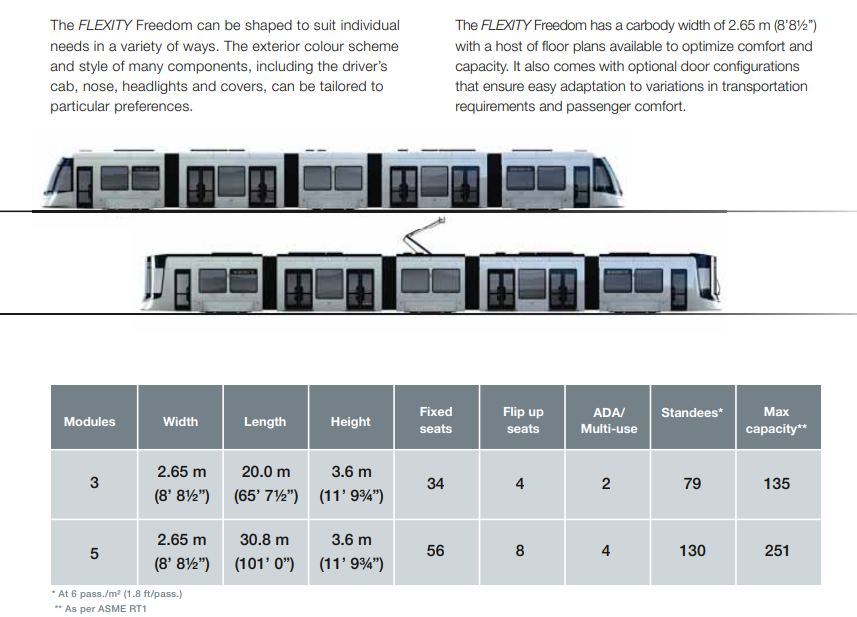

I've spoken about this enough in my previous posts, so feel free to look at them and my sources for the 200-250 number and the theoretical capacities of 9,600 pphpd. Unless you have sources to show me to dispute the LRV capacity and theoretical pphpd of Line 5, I don't want to continue this discussion.

I do agree that the LRT will be a magnet for traffic. How much extra traffic on top of the current 2,000 pphpd is to be seen a few months after Line 5 opening.

The location was also announced this morning and CablePulse24

Given the location, much less sure of a Line 5 or Line 6 related announcement. :(


Attachments

  • 1750161291340.png
    233.8 KB · Views: 35
So according to metrolinx the line was transfered to the ttc last week. Everyone has been trained on the trains. All 28 lrvs should be running on the line today and are being stressed tested when this is done (no estimate given here), this is followed14 days of testing, then 30 days of revenue service, then a bedding in period (anyone know what that means ?) and if ...if everything goes well a sept opening Date will become reality.

Personally I remain skeptical..the timeline is getting tight. Hopfully I'm wrong

Highlights from Michael Lindsay's part of press conference today:
  1. As of today/yesterday all control was handed over to TTC - all movement on the line governed by the TTC at Hillcrest now
  2. Full complement of 28 trains running on the line
  3. All civil infrastructure is complete
  4. All operator driving training complete
  5. Big emphasis on stress testing, a lot of emphasis on avoiding another Ottawa LRT situation
  6. Next steps: formal trial run for 14 days, full revenue service demonstration for 30 days - then have a “bedding in period” to continue with testing (An extra period of testing recommended from the Ottawa LRT report)
Ford: Wont open until its 100% safe

Seems like a big emphasis on getting it right on opening day and avoiding an Ottawa LRT 2.0 on Eglinton

Highlights from Michael Lindsay's part of press conference today:
  1. As of today/yesterday all control was handed over to TTC - all movement on the line governed by the TTC at Hillcrest now
  2. Full complement of 28 trains running on the line
  3. All civil infrastructure is complete
  4. All operator driving training complete
  5. Big emphasis on stress testing, a lot of emphasis on avoiding another Ottawa LRT situation
  6. Next steps: formal trial run for 14 days, full revenue service demonstration for 30 days - then have a “bedding in period” to continue with testing (An extra period of testing recommended from the Ottawa LRT report)
Ford: Wont open until its 100% safe

Seems like a big emphasis on getting it right on opening day and avoiding an Ottawa LRT 2.0 on Eglinton
Still "hunting" through Metrolinx websites today (as of 10:30 AM), and NOTHING about handing over to the TTC from Metrolinx. Not very "transparent".

What are the headways with 28 trains running? Is that what it will likely be at rush hour when service starts?
