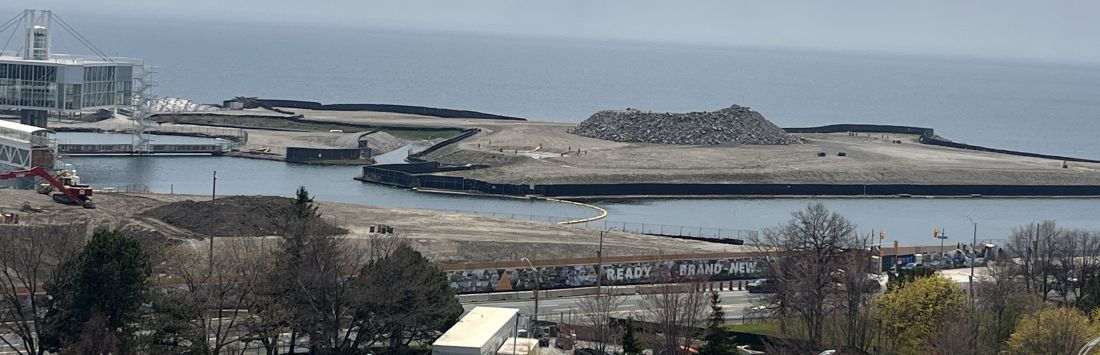

Well, they're behind schedule, but it seems they've recently applied for an infill permit:

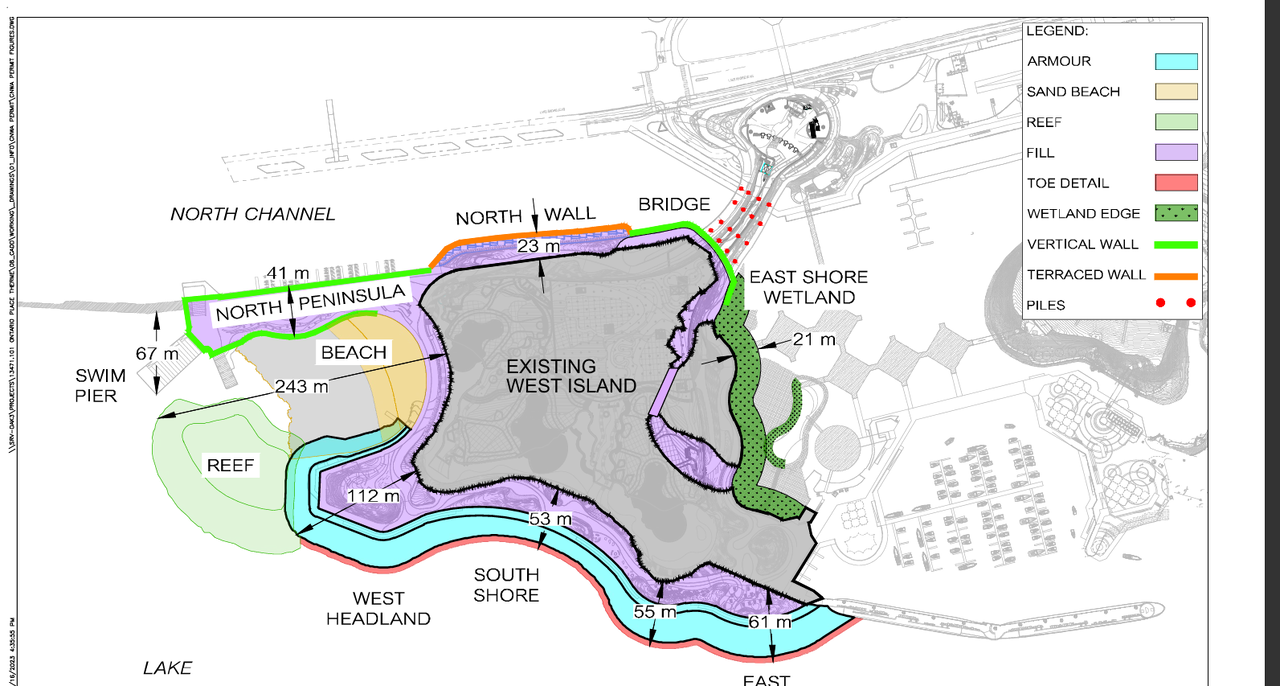

File 2026-416695

- erosion protection and infil on southwest corner
- construction start april 2027 until january 2030

- SAND? beach extension and lake infill. I thought that was canned for a full rock beach?
- construction start april 2028 to january 2030

- north peninsula and wall construction
- construction starts march 2028 to june 2029

- mentioned above. This is an access road to support construction to be later used as the new MGT. Also support for the east shore.
- construction starts july 2026 to july 2027

- infill access road where the old bridge was. So trucks can cross apperently
- construction starts july 2026 and "completion" is mid-2030 but probably because thats when the infill gets removed

- this one seems like some kind of generic application for shoreline infil
- construction start july 2026 to September 2029.
