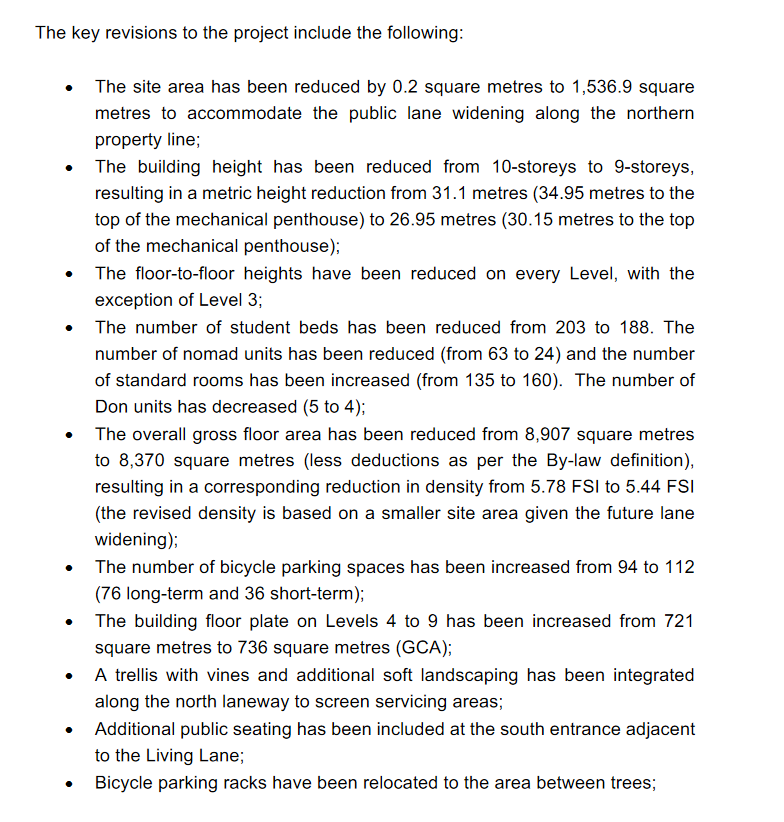

From the Jan 22, 2021 Planning Rationale Report:

From the Jan 22, 2021 Architectural Plans:

^ Looks pretty cool!

A reduction in the site area of 0.2 square meters to widen the laneway.... that seems like a rather low figure. That amounts to something very very small.

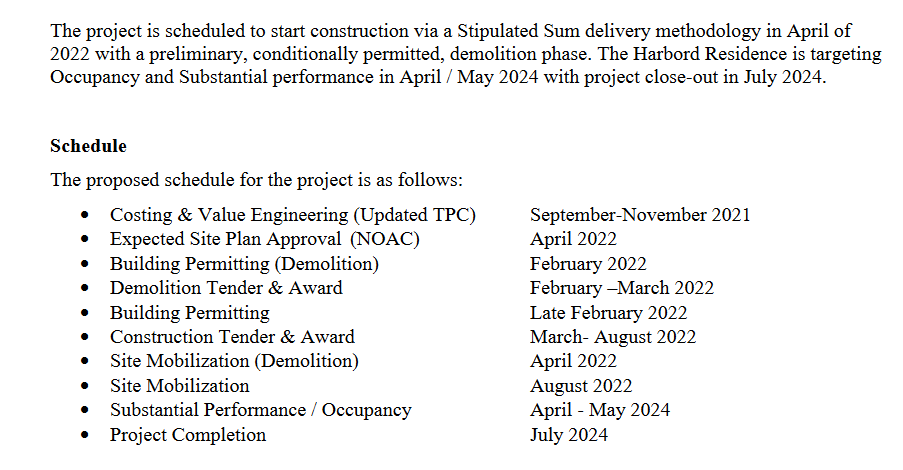

The forecasted construction timeline of around August 2022 to July 2024 sounds a bit overly optimistic. The going average for buildings of this size in the city is typically closer to 3 years. So I wouldn't be surprised if this ends up getting completed in 2025 instead. Some of U of T's other recent ongoing projects like the Robarts expansion and Student Commons on College have also been slower movers.

More of these types of building please!

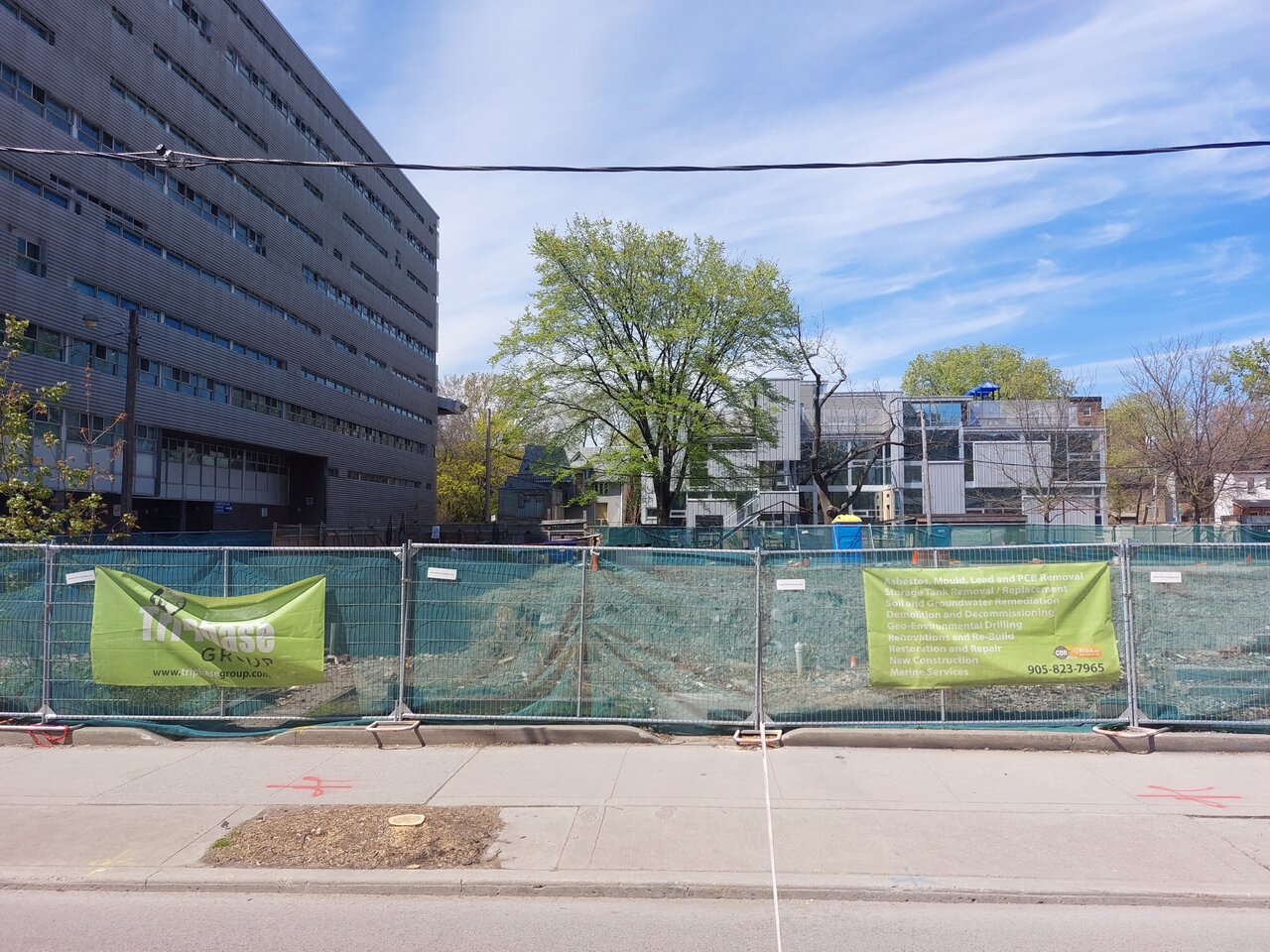

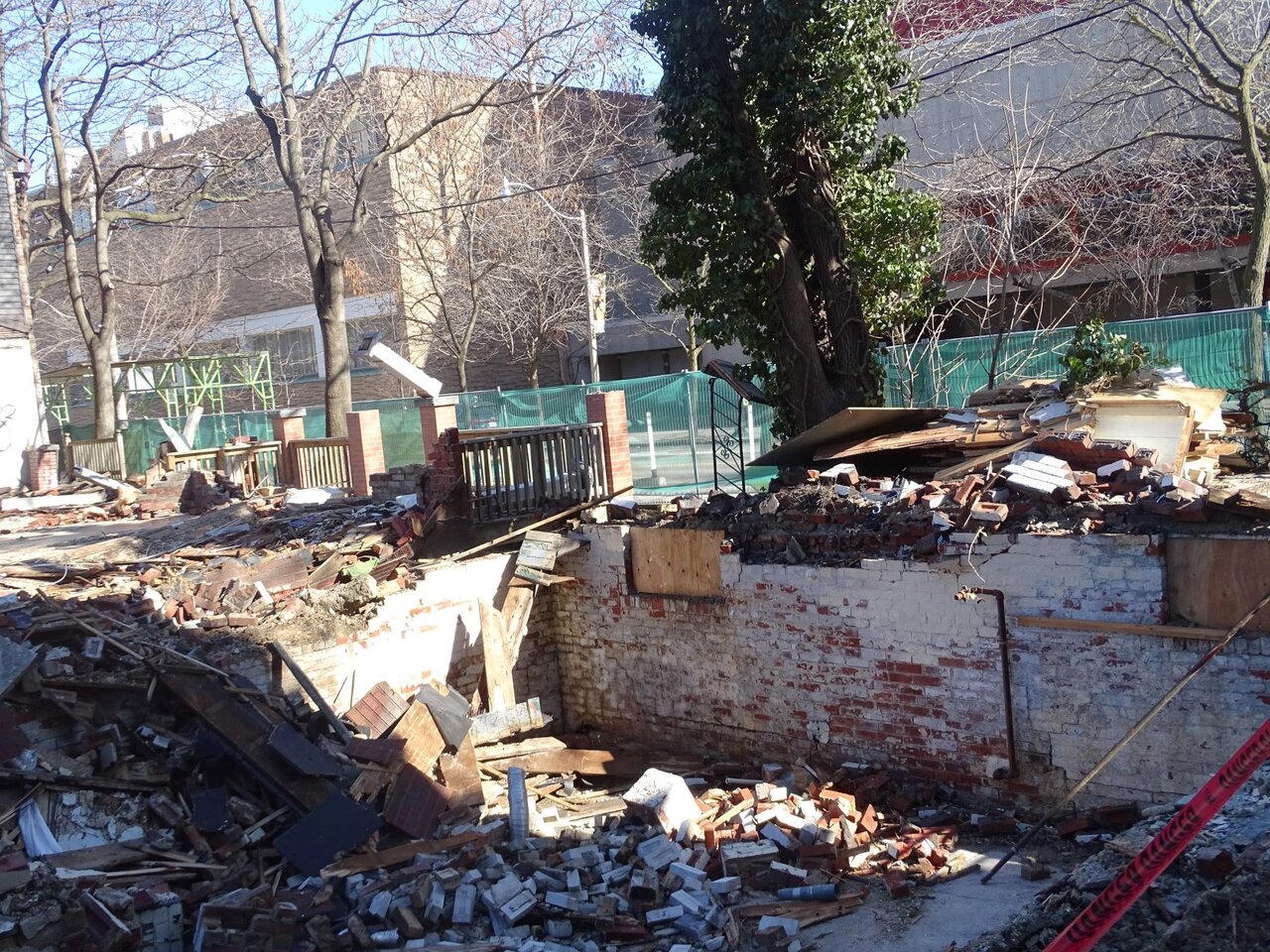

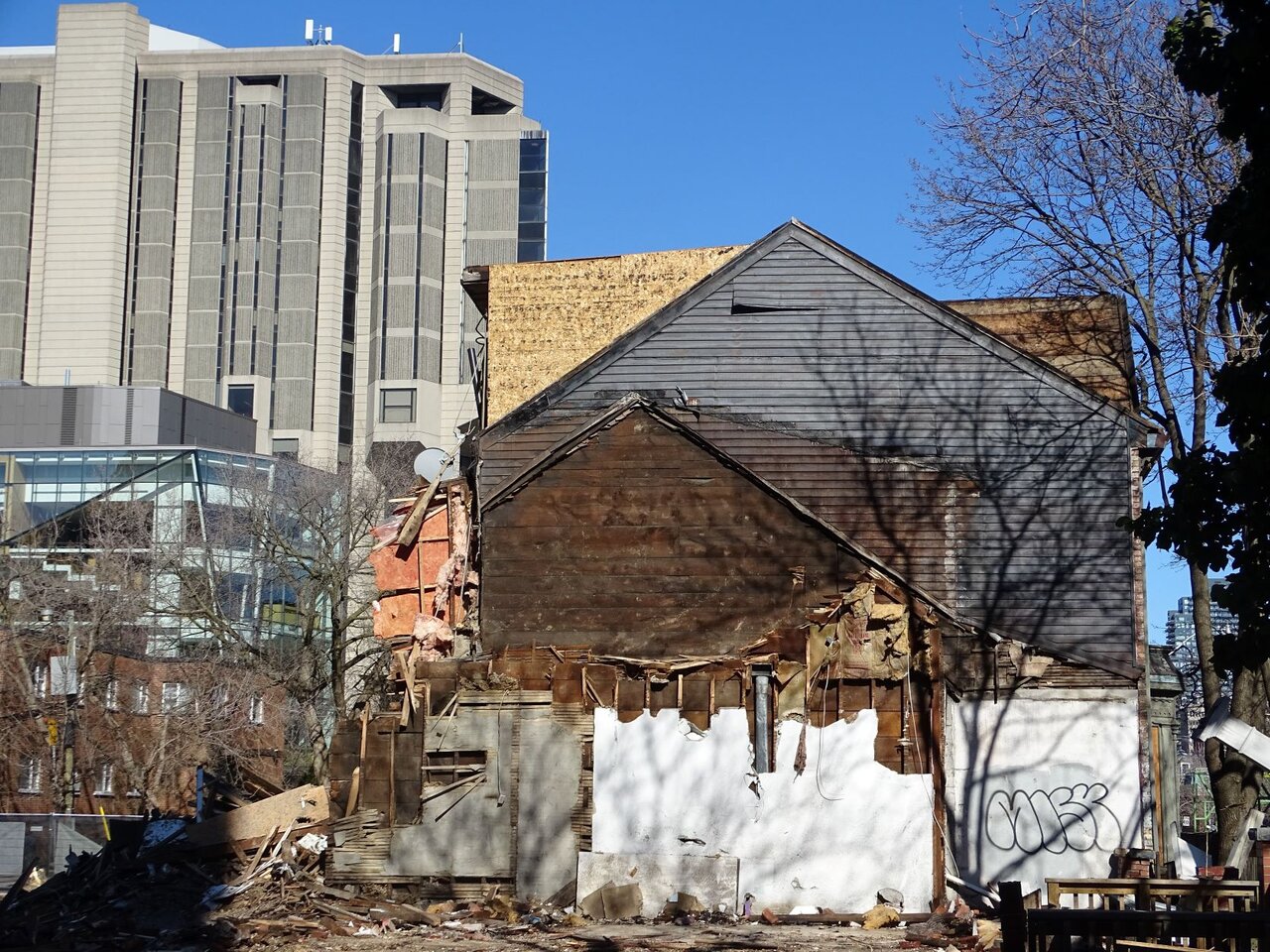

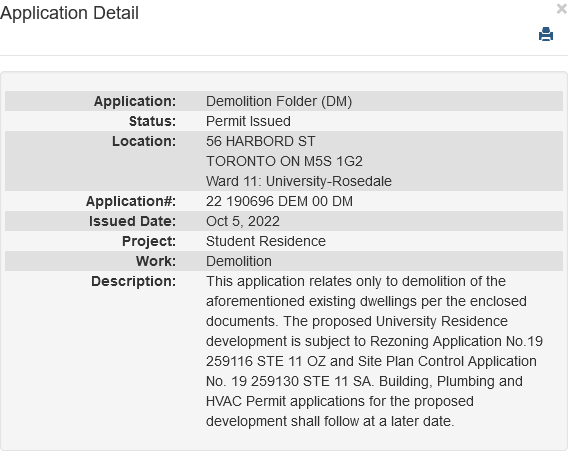

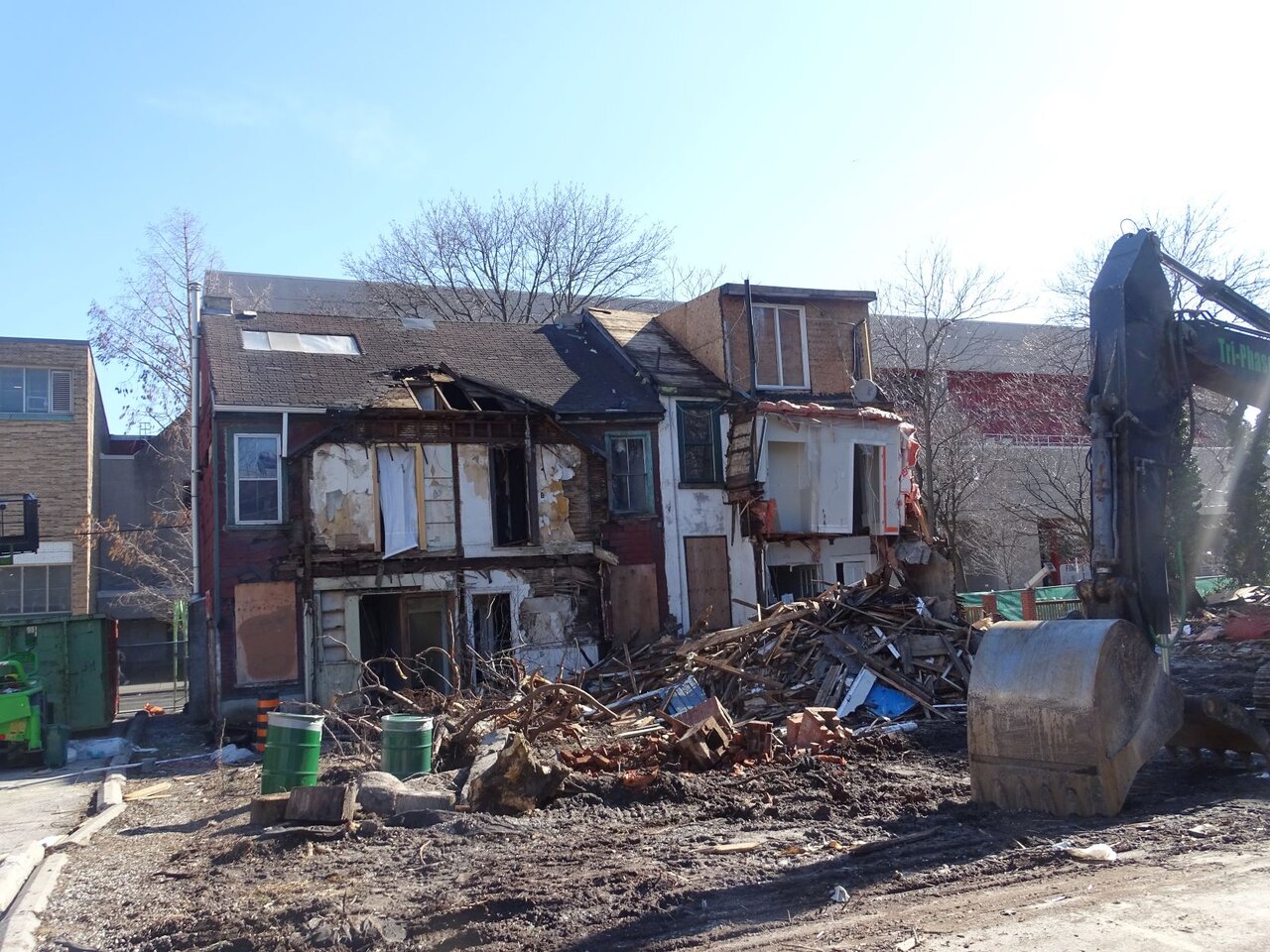

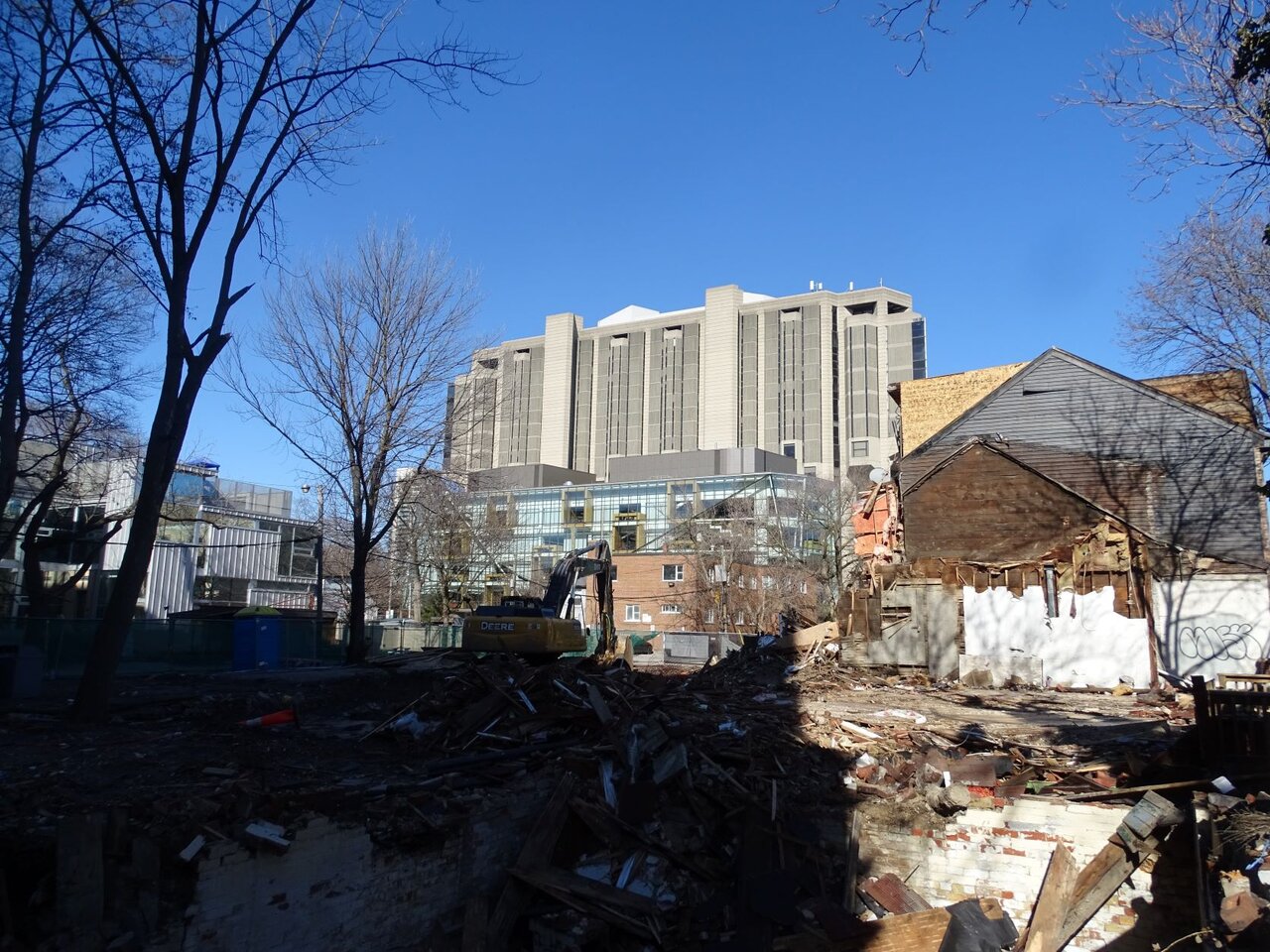

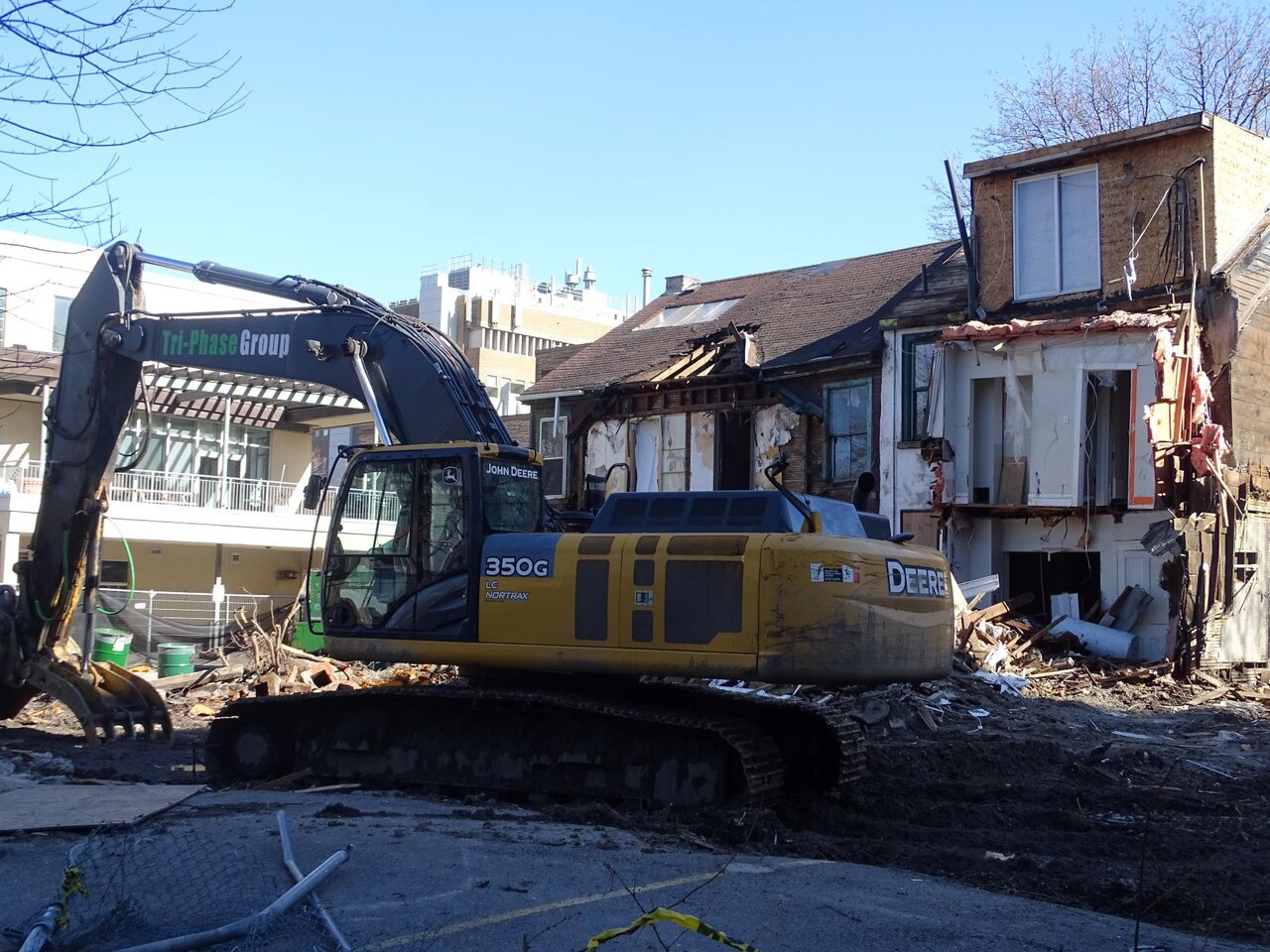

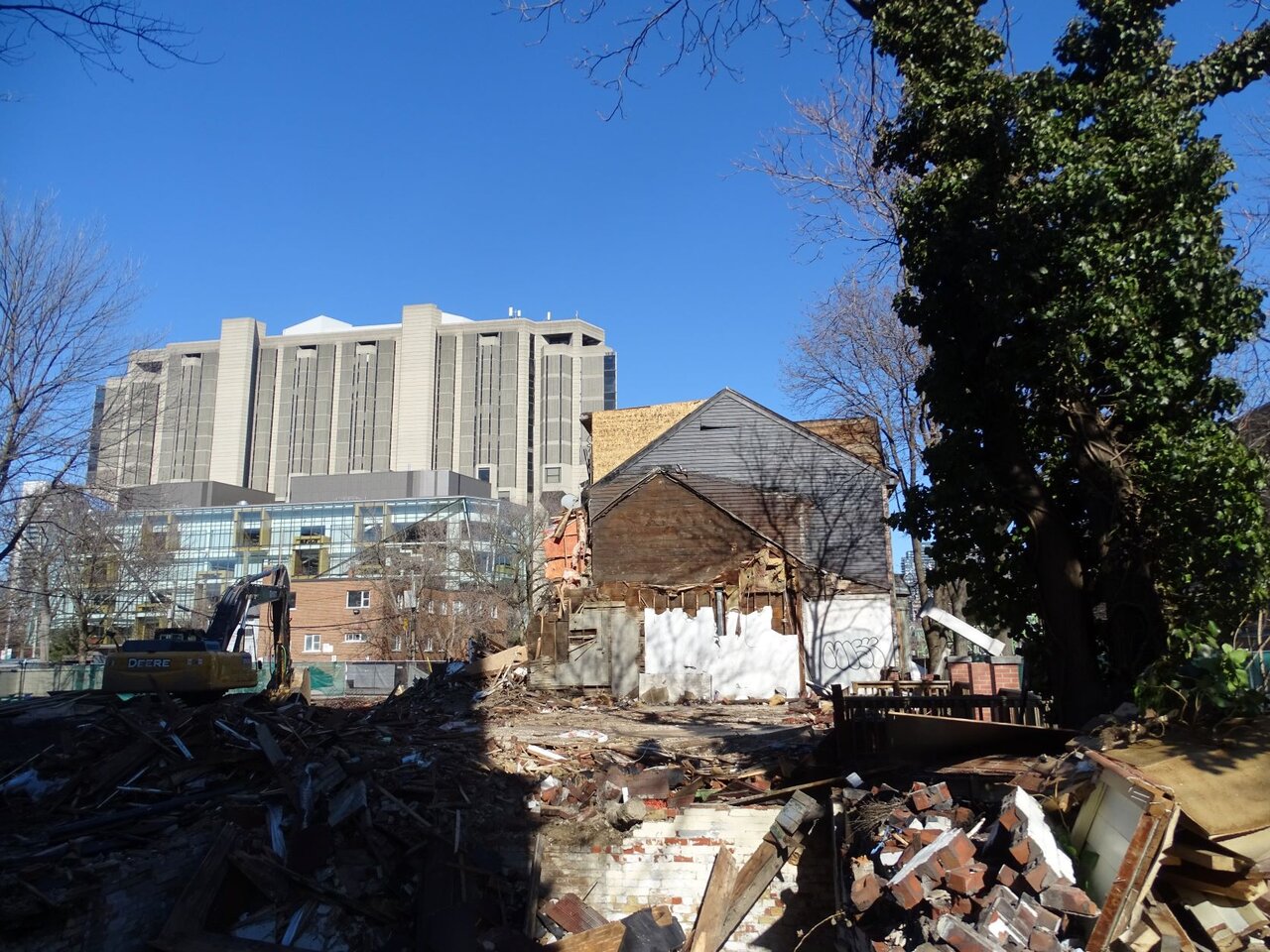

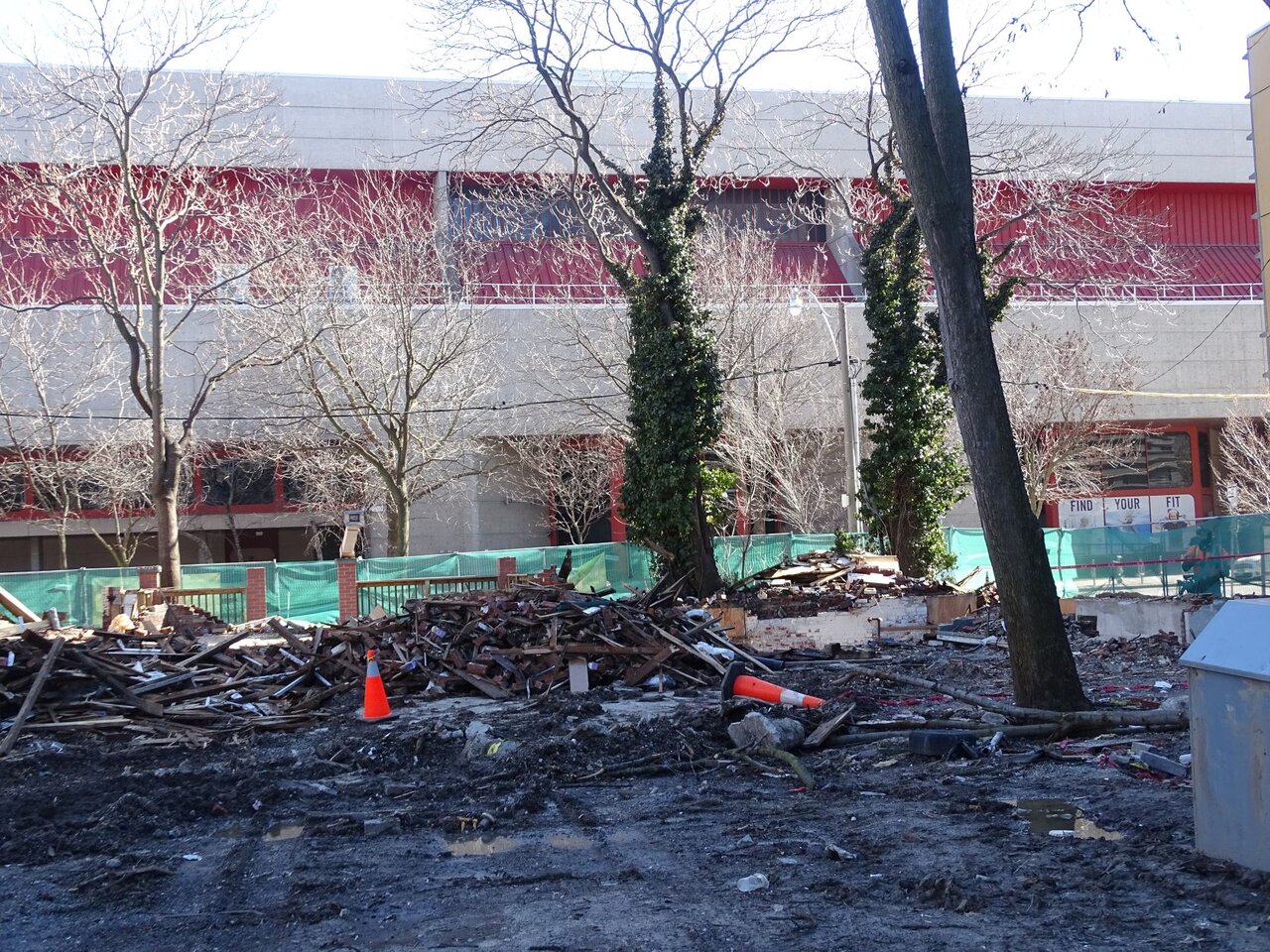

Demolition Permits have been issued for everything here:

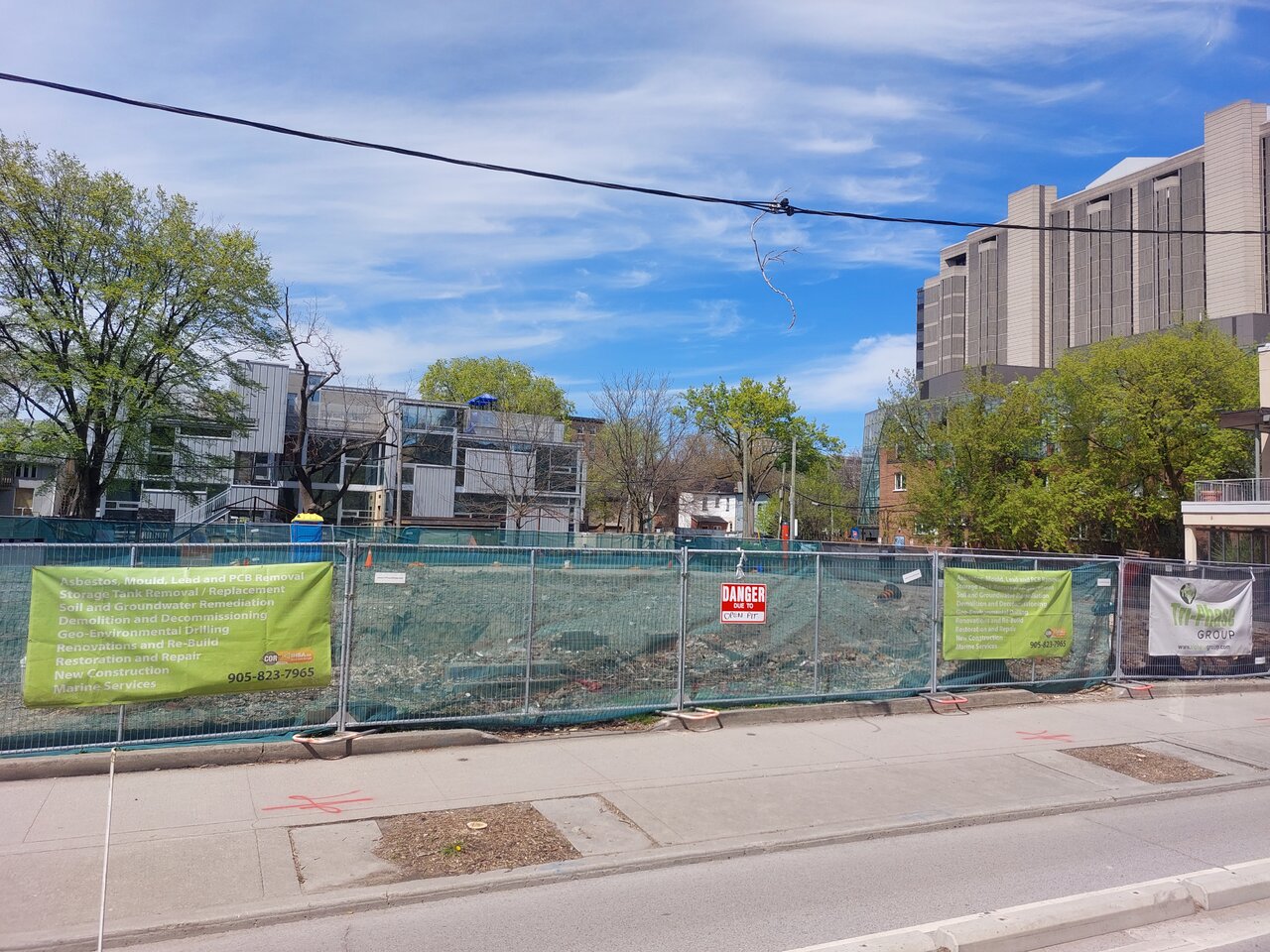

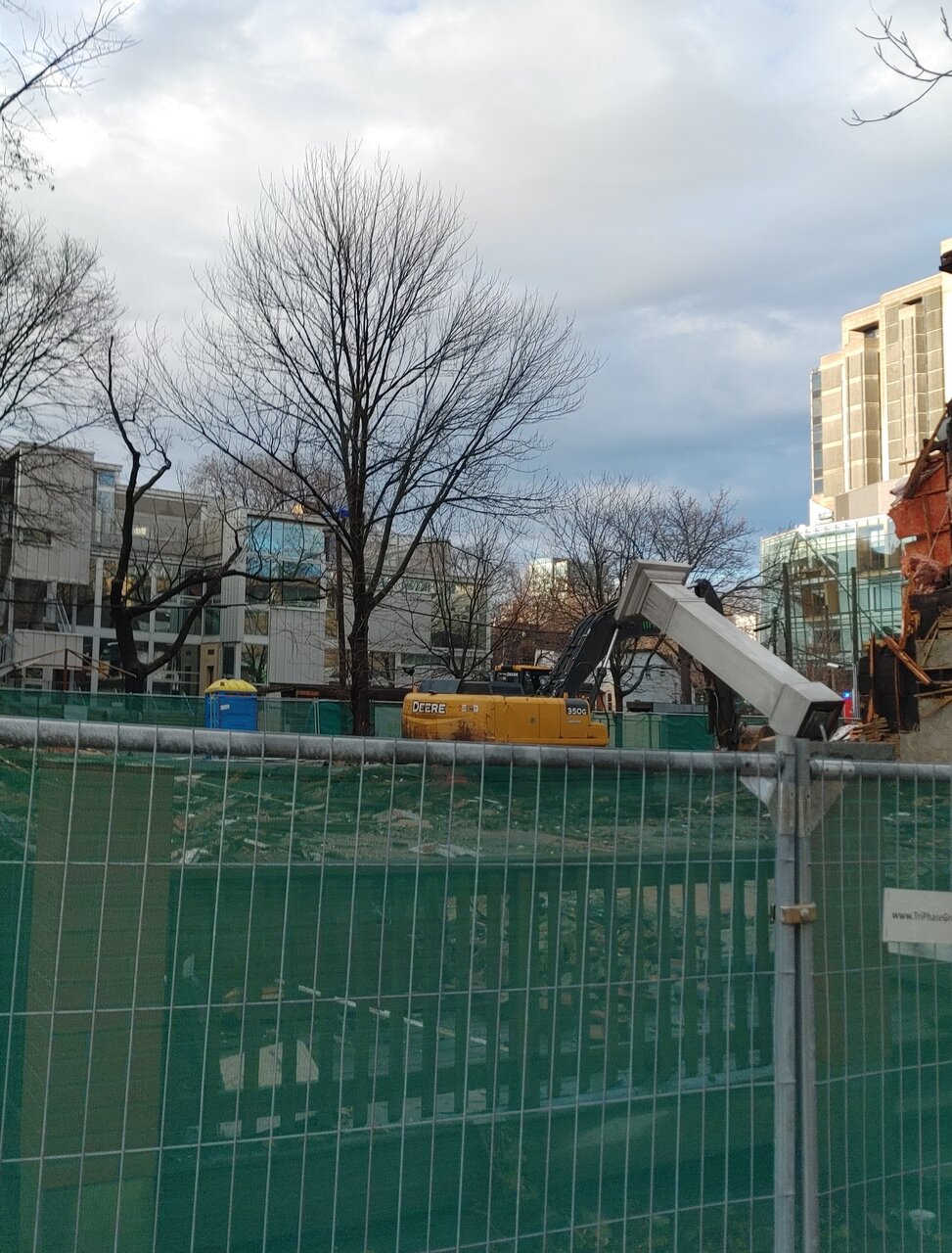

New build permits are still not showing as applied for...
