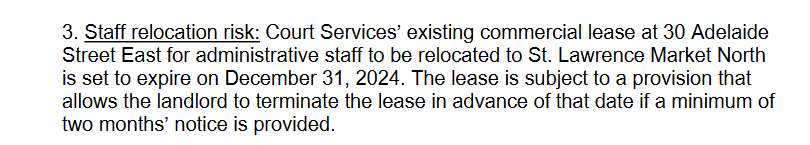

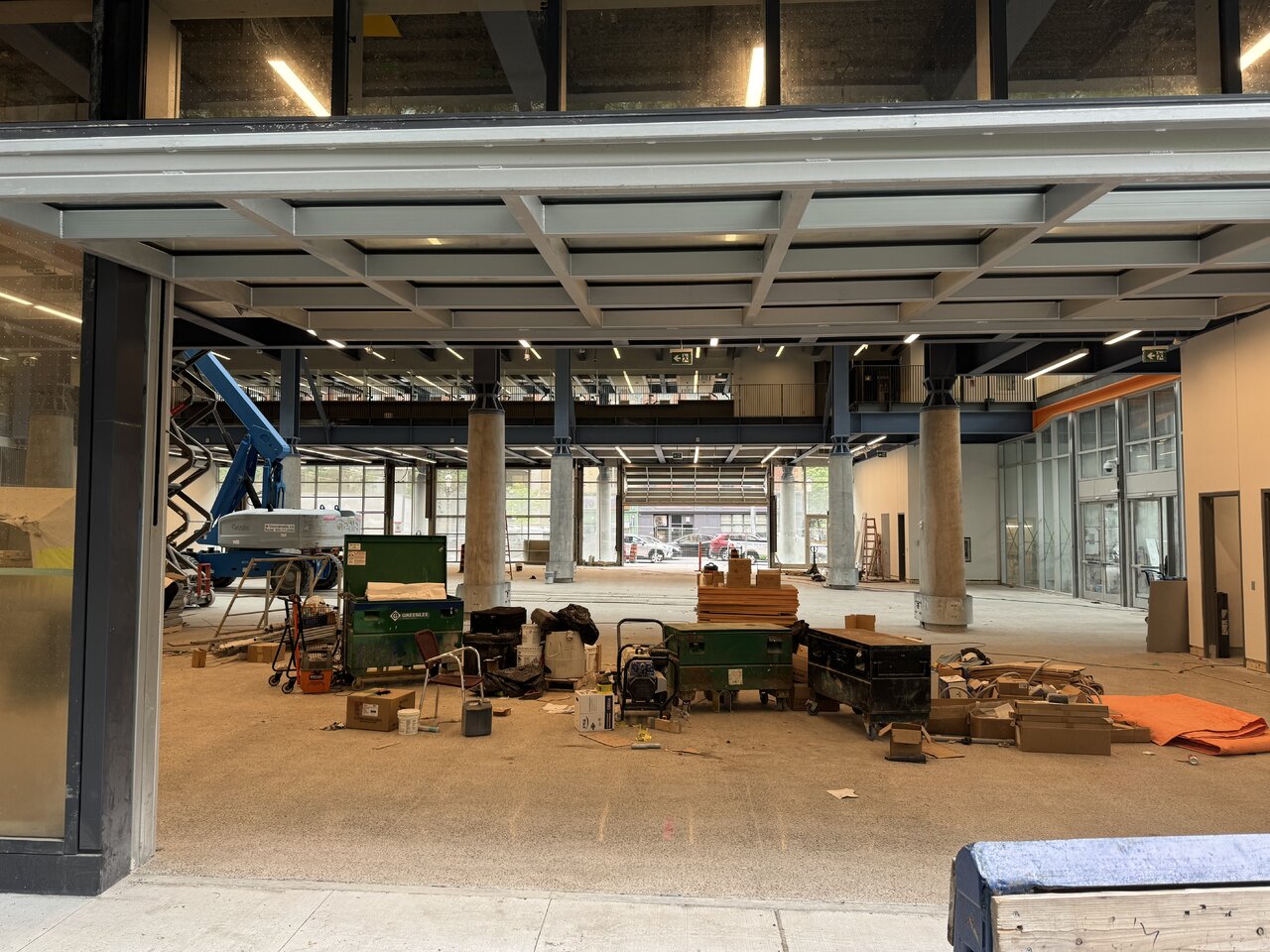

The Courts are the top priority as their leases are ending, soon.Computer equipment has been moved in to the offices on the second floor. Taken 19 June.
View attachment 573828

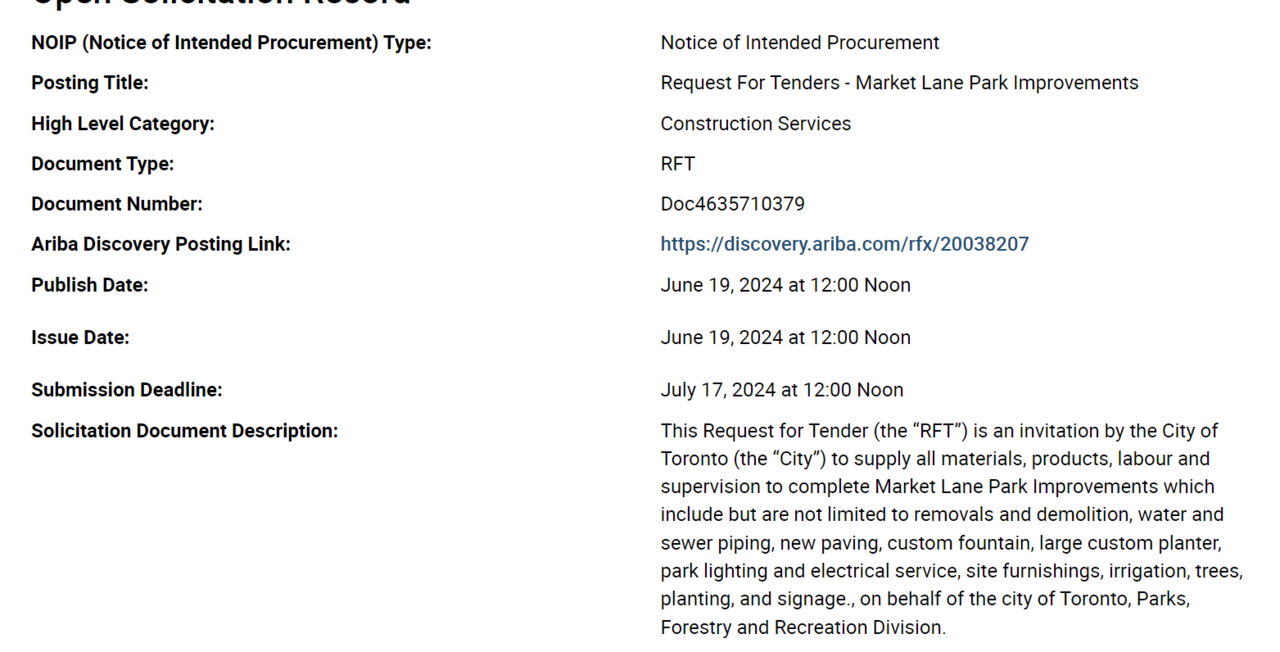

Based on the poor project management in this project to date, any excuse will doubtless be siezed upon! The MARKET should be totally independent of the Courts (though MIGHT require garage on market days) but .....Thanks! So does the delay in one part of the building delay opening the market, for example?

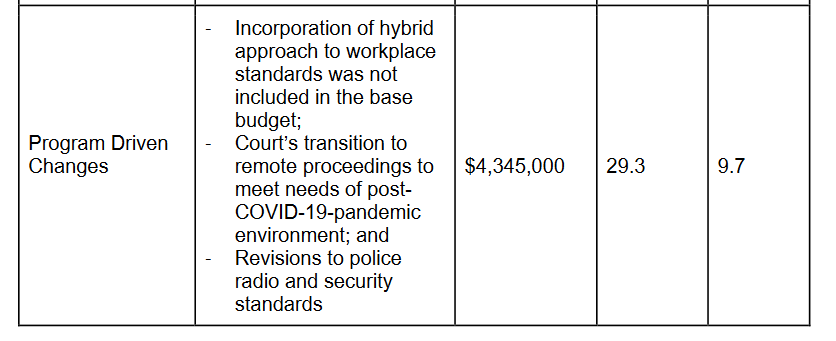

Clearly it would include the savings for painting the Orange Trumpets Grey!!I would like to see the change order log.
...I think that could have another meaning State side. >.<Clearly it would include the savings for painting the Orange Trumpets Grey!!
Not to say "we knew this was a VERY poorly managed project" but we did - for many years and I doubt that all the blame can be placed on "one former staff member".City needs $9.5M to finish St. Lawrence Market building
The City of Toronto is poised to drop $9.5 million in emergency spending to keep construction of the St. Lawrence Market north building on track — and a serious internal management issue is partly to blame, a document obtained by CBC Toronto shows.
