This is such an incredible forum with so much great information. It is tough to see the progress or lack thereof for this project!
I live on Laing Street and was excited for some new development but for a side street, this is anything but gentle density.
If this size of application was for a site location that fronted onto an arterial road such as Queen or Eastern (for example the abandoned building at the south west corner of Laing and Queen), then I would be all for it. But to apply for a major project on a side street that is already congested is a surprise to me and there are endless more appropriate sites within 500m for a project this size.
I am trying to follow the progress to understand a realistic timeline as I know the neighbour's would like to be heard.
If you can educate me on a realistic timeline that would be great as I just spoke to a developer representative on site who said "we are breaking ground soon" but upon further review that looks like BS.

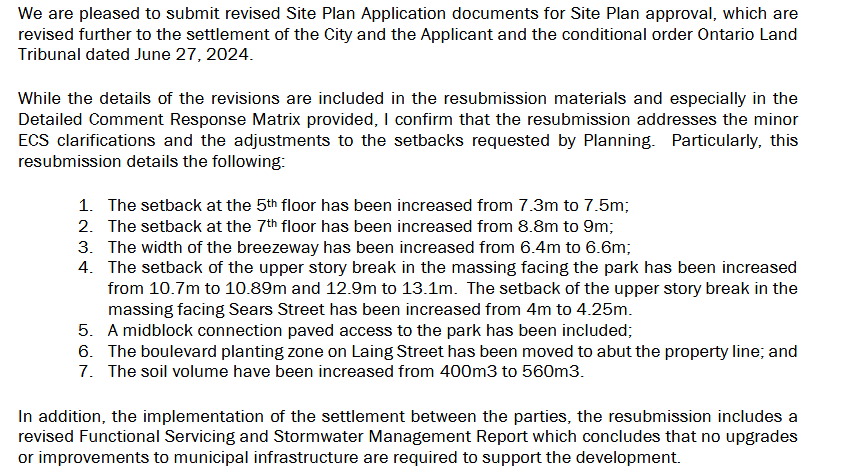

Further technical revisions were submitted to the City in February '26
@Paclo
NOAC has not yet been obtained. For your purposes
@lmlotek this is a necessary step (generally) towards getting building permits.

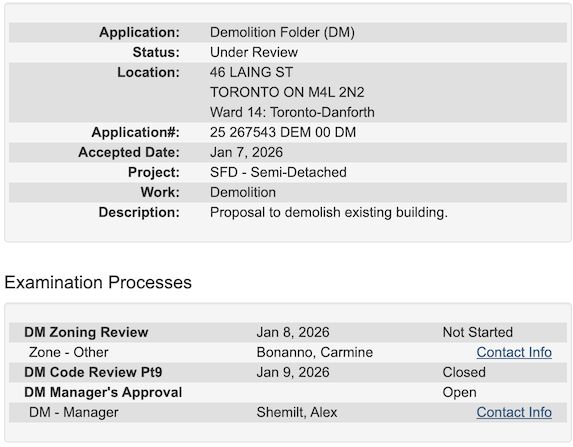

None of the demolition permits for the existing houses has yet been issued.

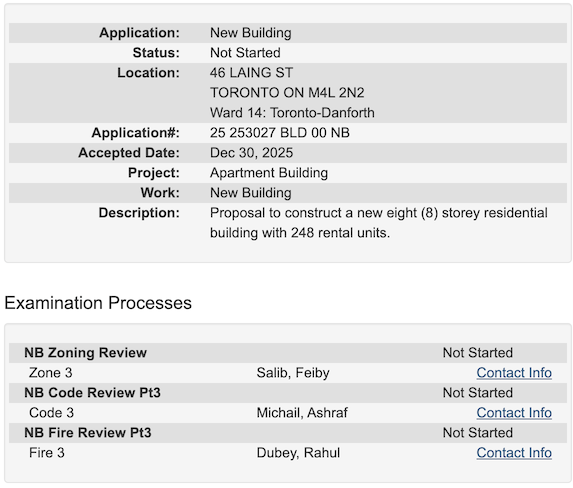

No permits have been filed for the new building.
***
A realistic schedule for building here isn't straight forward in that the proponent/developer will have to decide if they really want to build, go get financing and then make it happen.
Whether that's the plan here is TBD.
The best that can be said at this point, given that we're in May, is that there is no realistic prospect for building here before mid-fall at the earliest, though demolition, if approved may come sooner.
Normally demolition permits are not issued until new build permits have been filed, earlier permits usually require Council approval.
