April 19, 2026

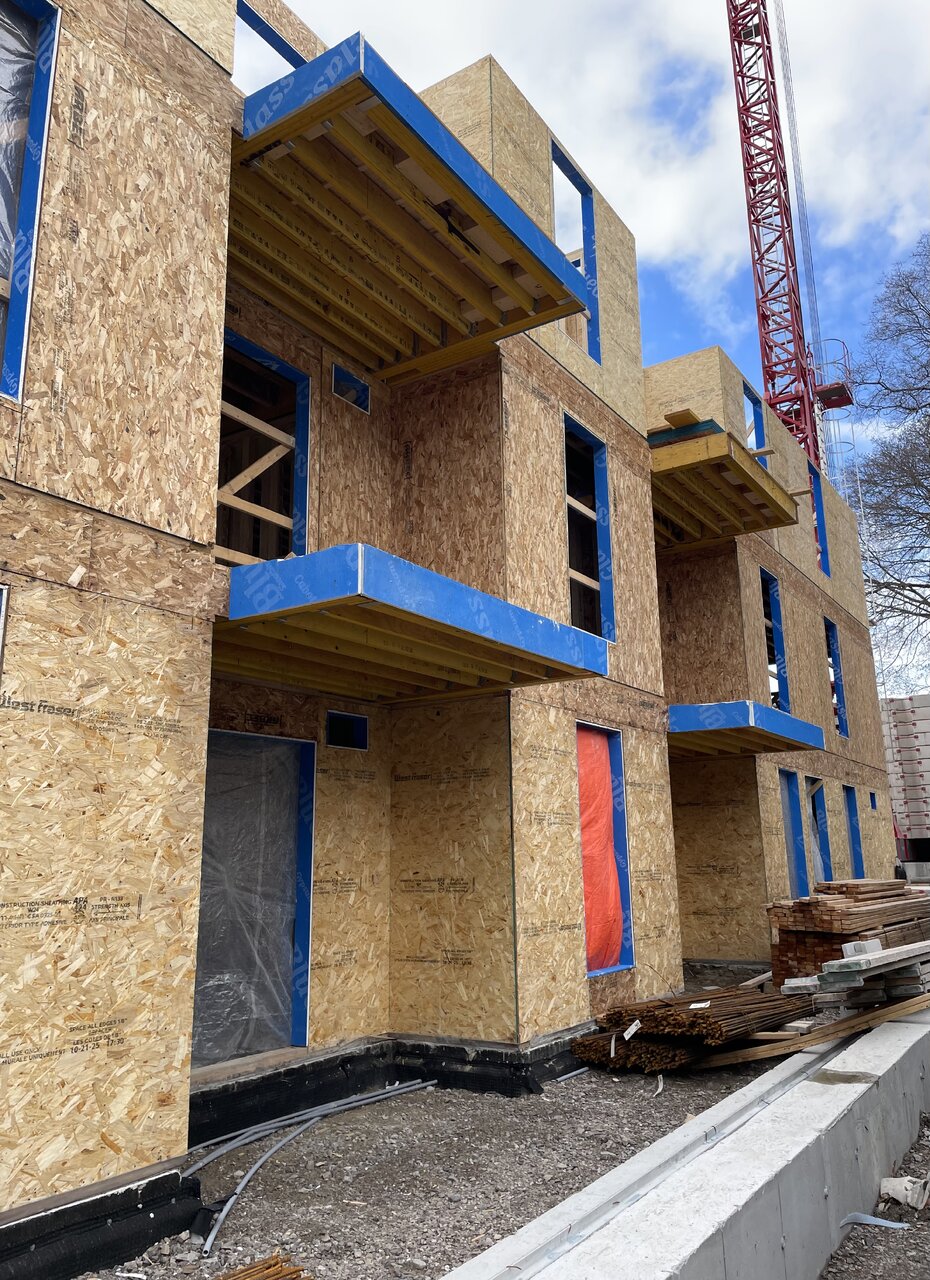

Some close-ups of the assembled panels that make up the exterior walls...

Photo 2026-04-19, 9 51 47 AM.jpg

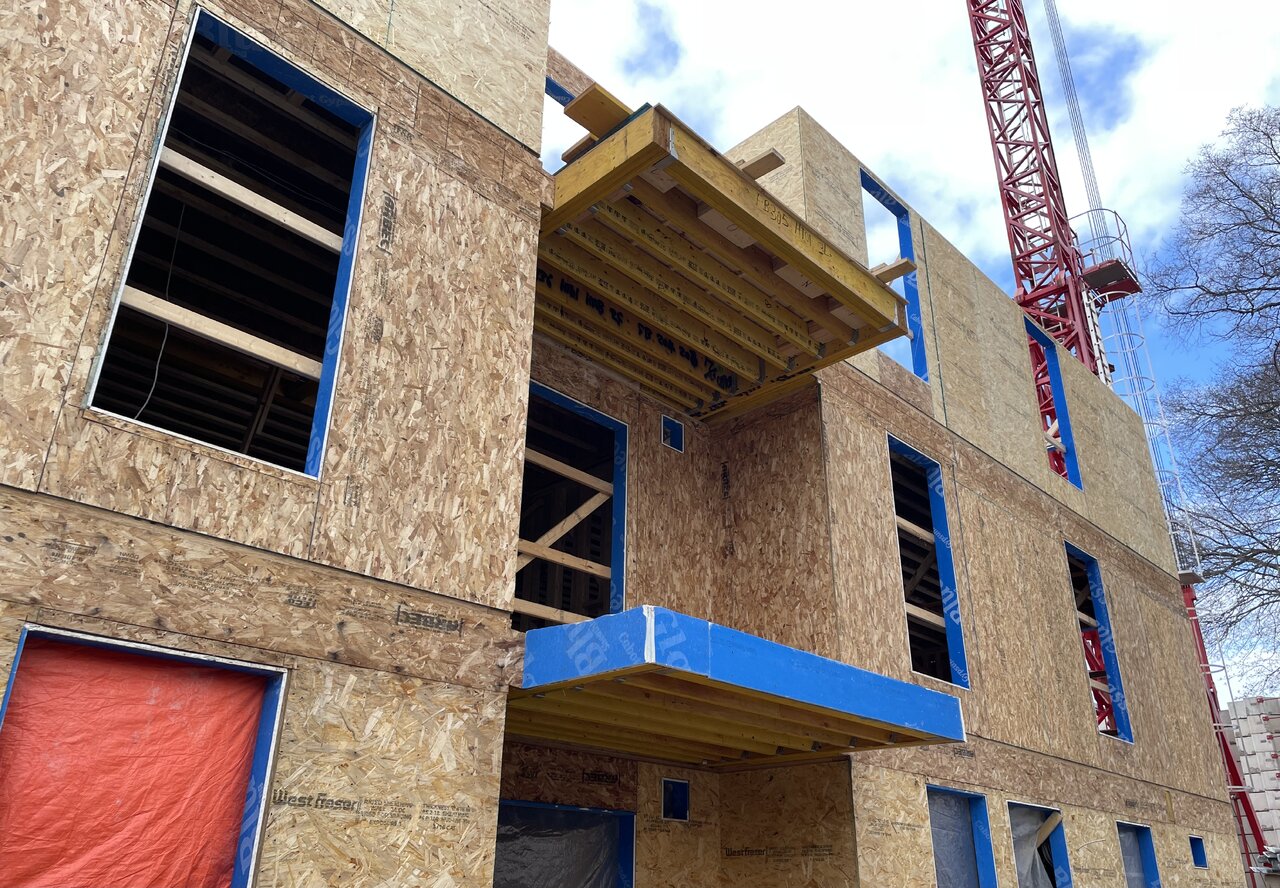

Photo 2026-04-19, 9 52 08 AM.jpg


Somewhat surprised by WOOD balconies..??

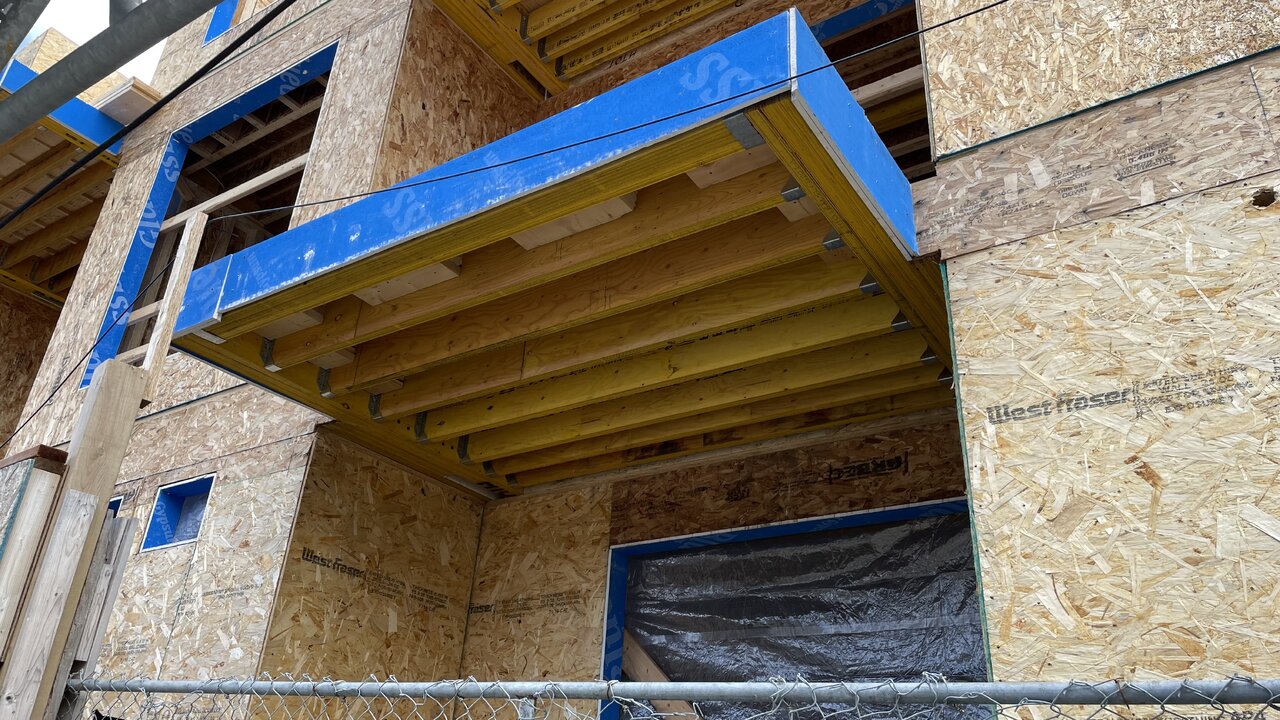

Photo 2026-04-19, 9 54 38 AM.jpg


Photo 2026-04-19, 9 55 30 AM.jpg

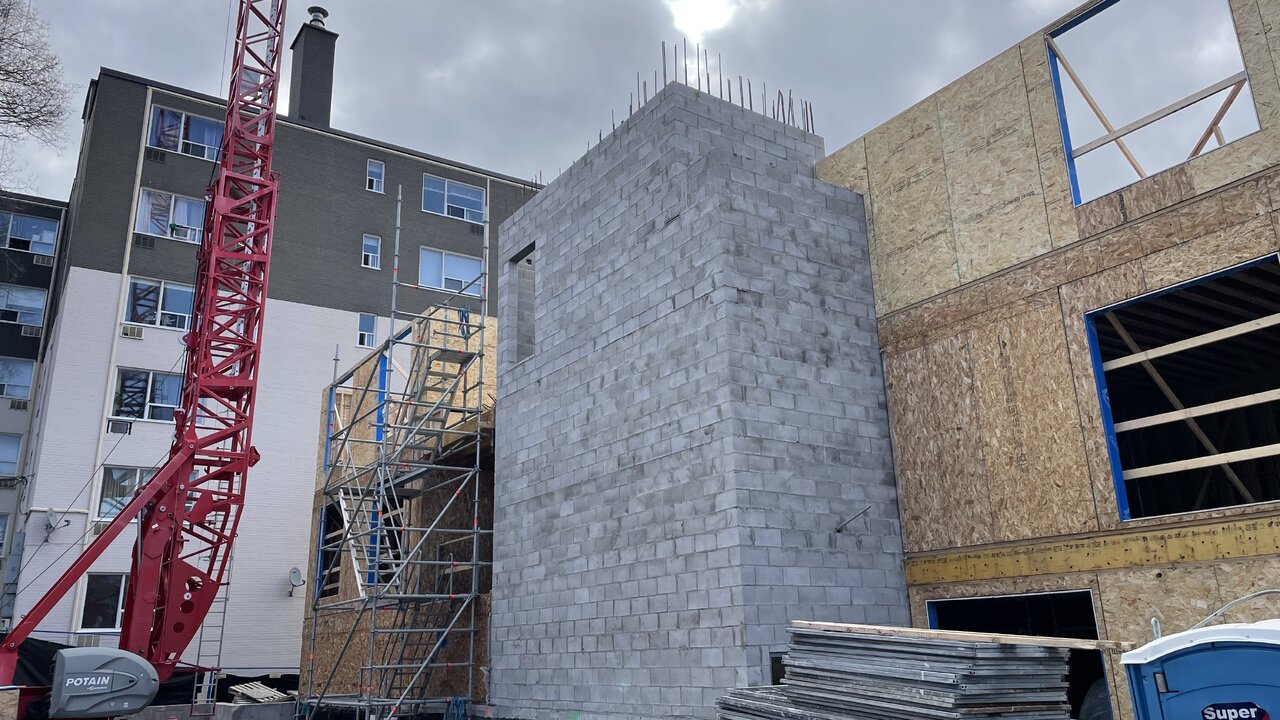

Photo 2026-04-19, 9 55 04 AM.jpg

FEB. 28th, 2026 - End-of-Month Update

View attachment 718381

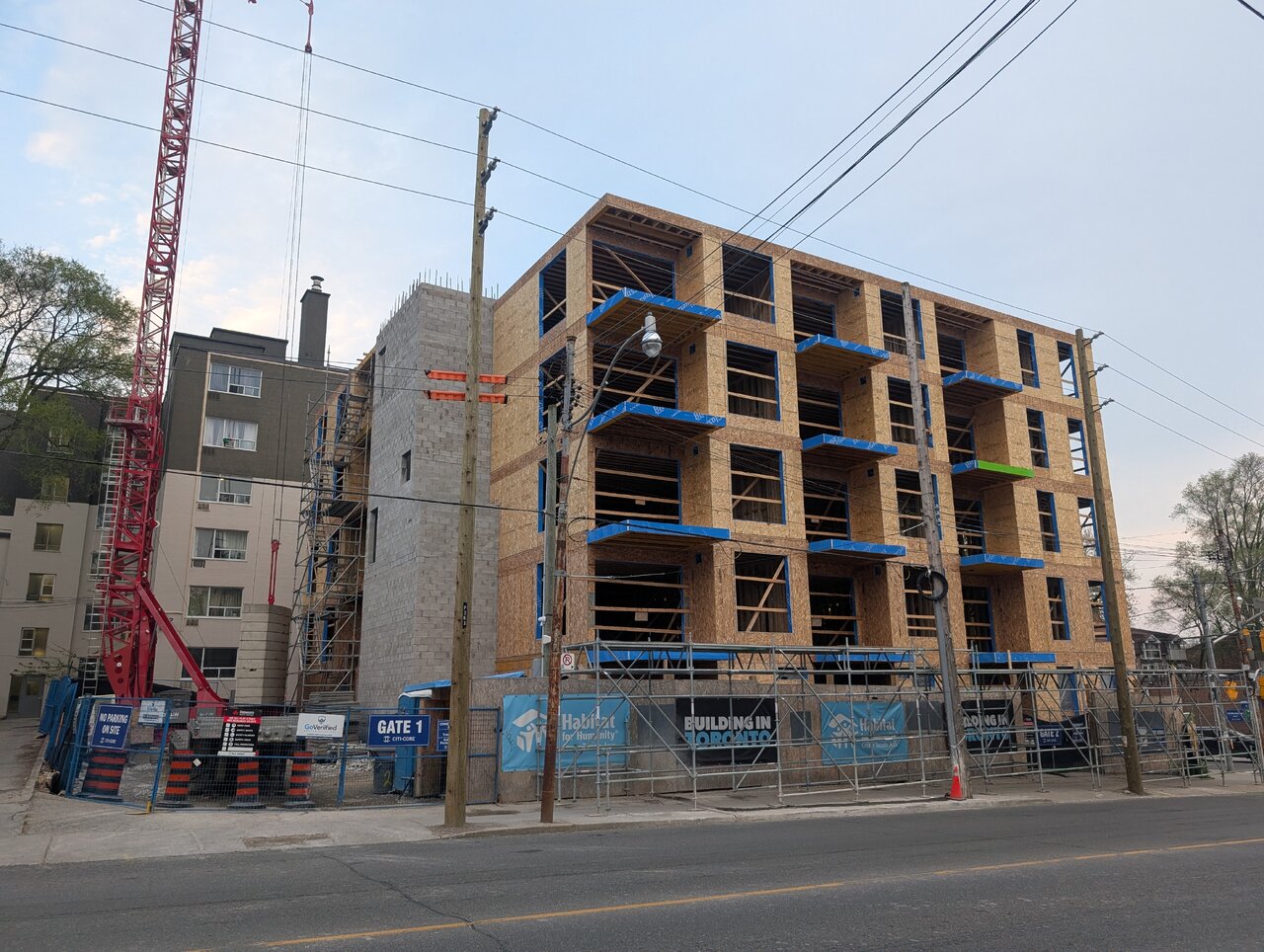

Base structures are now above ground and above the height of the safety fences...

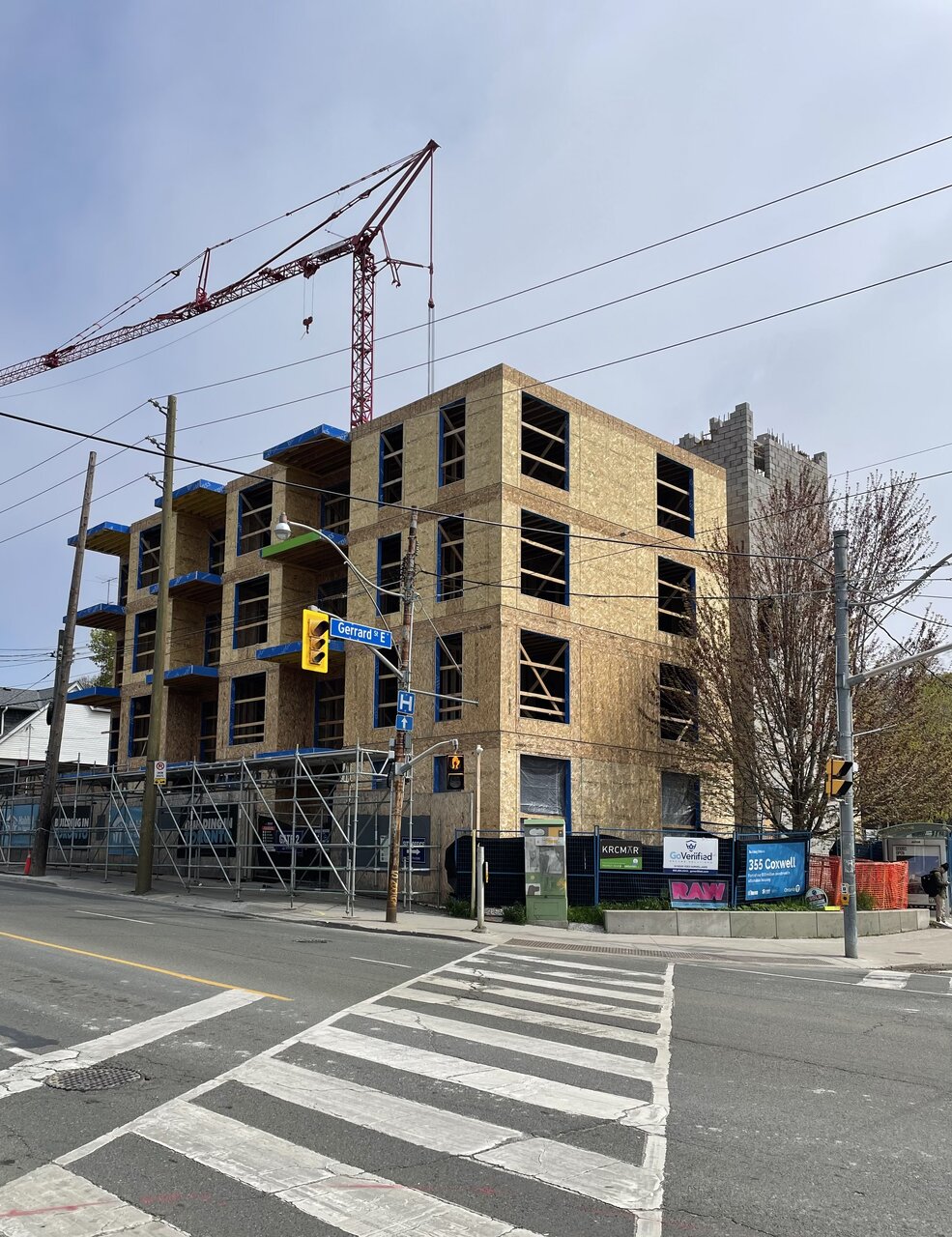

View attachment 718382

View attachment 718383

View attachment 718384

View attachment 718385

Expecting the Crane to start lifting wall-panels in the next few weeks.
JUNE. 2nd, 2026 - Start-of-Month Update

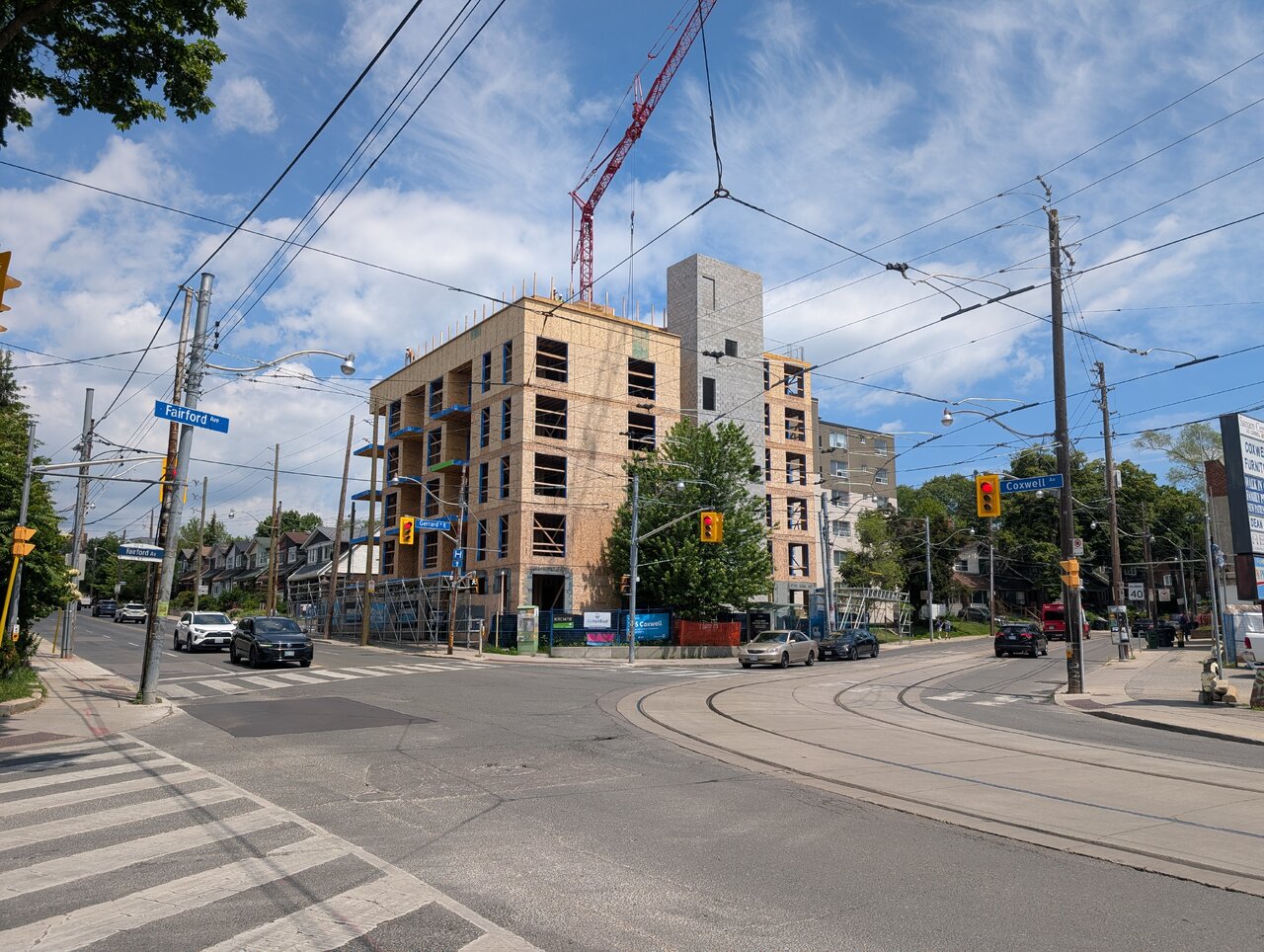

In just 3-months, this 6-Storey building has now "Topped-Out" at Coxwell & Gerrard...

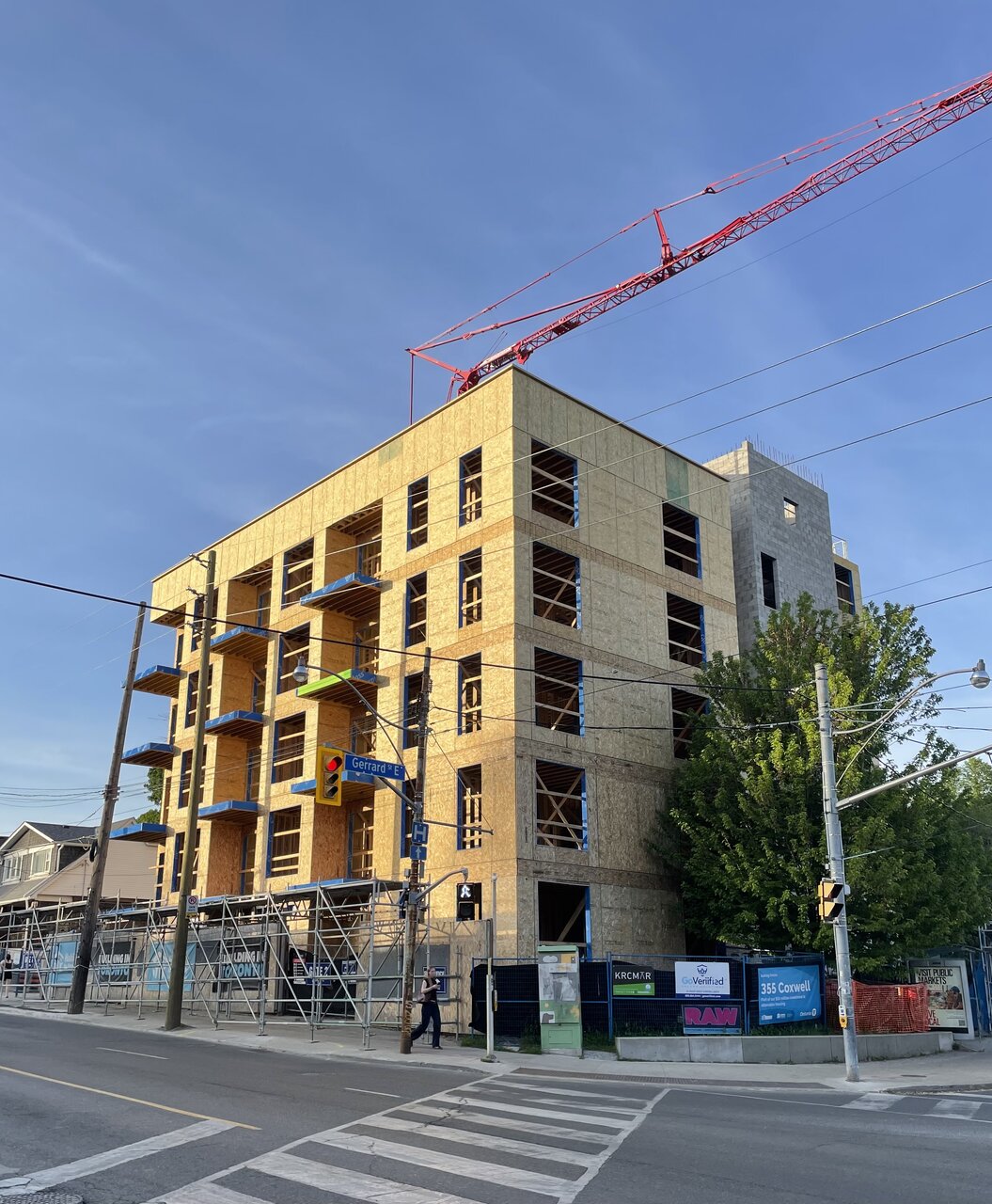

Photo 2026-06-02, 7 40 58 PM.jpg


...and it probably would have been even FASTER it they used a cement-panel system for the Fire-Stairs and Elevator-Shafts instead of Block-Masonry.

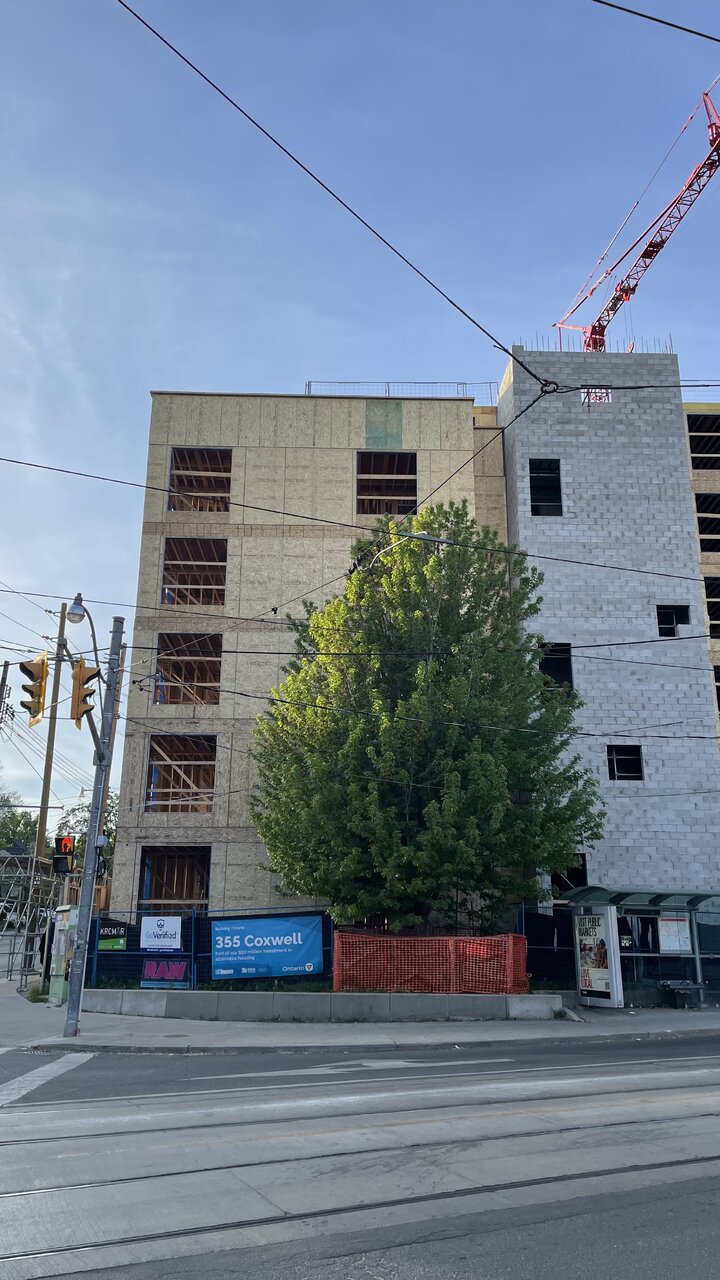

Photo 2026-06-02, 7 38 42 PM.jpg

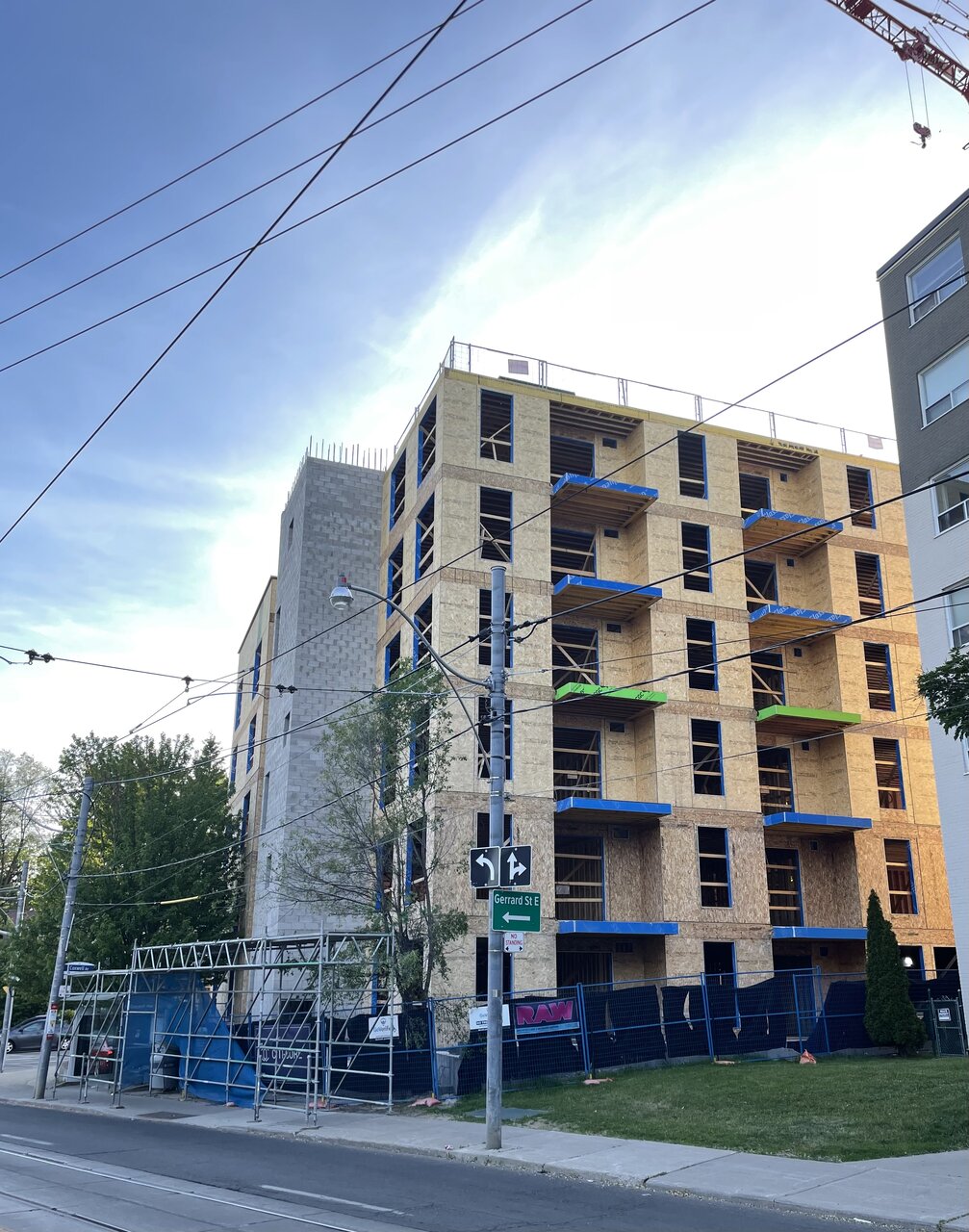

Photo 2026-06-02, 7 37 42 PM.jpg

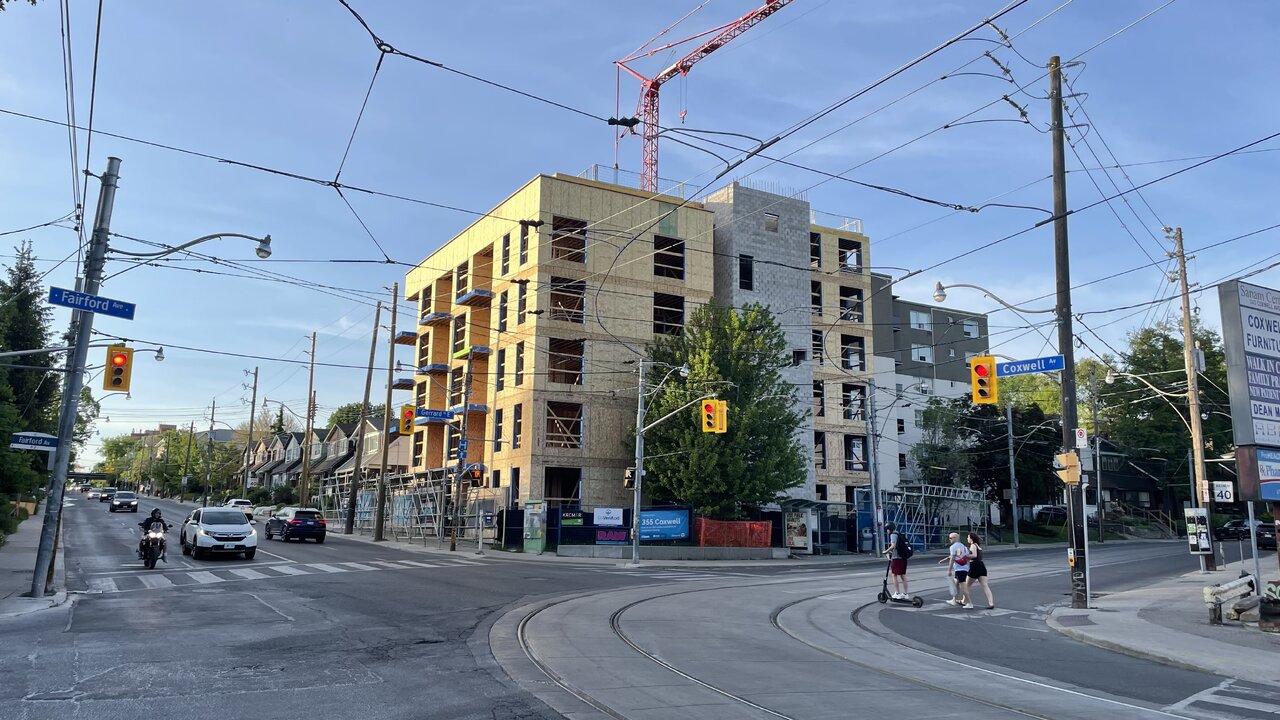

Photo 2026-06-02, 7 40 15 PM.jpg

JUNE. 2nd, 2026 - Start-of-Month Update

In just 3-months, this 6-Storey building has now "Topped-Out" at Coxwell & Gerrard...

Sometimes, your sarcasm is hard to detect.

This building has risen at a rate of 1 floor per 4 weeks, approximately, which is roughly 2 x the industry norm for tower form, and 3x or greater the Centrecourt gold standard.

I mean sure, at least this wasn't the 1 floor per year pace over on Logan, LOL.... but it was not particularly speedy.

Sometimes, your sarcasm is hard to detect.

This building has risen at a rate of 1 floor per 4 weeks, approximately, which is roughly 2 x the industry norm for tower form, and 3x or greater the Centrecourt gold standard.

I mean sure, at least this wasn't the 1 floor per year pace over on Logan, LOL.... but it was not particularly speedy.
It is FASTER than any 6-Storey Building that I have seen in the Toronto-Danforth or Beaches East-York zones south of Danforth in the last 20+ years.

It is FASTER than any 6-Storey Building that I have seen in the Toronto-Danforth or Beaches East-York zones south of Danforth in the last 20+ years.

Pretty comparable to Two Hundred the Beach which was June 2016 - December 2016 for comparable size.

Slightly faster than Lakehouse on Queen. First picture of construction shows work starting on the 3rd floor in July 2016, and again nearing completion at year's end.

Not any faster than Beach Club on Kingston Road, which was in the six month range for similar work, indeed Beach Club had the windows fully in within that time window, this project does not.

Canvas Condos on Danforth was ~ 8 months but for 8 floors, much larger building to reach full height and having cladding in progress.

Danny Danforth was ~10 months but was 10 storeys from grade to early glazing.

****

So nope, not really any faster than most comparably sized builds; you're just more excited about this one! :)

PS. not giving you a hard time, you made me curious, so I went to UT's map, screened for completed projects in the area around the same height/size and looked just to see if my memory was bad, it wasn't.

A floor a month is fairly common for inexperienced builders Best in class is a floor every 7-10 days, with 2 weeks being more common, but that only applies once you reach repetitive floors.
