As the topic of Line 2 SSE being delayed til 2033 has made the news, I thought I'd post my predictions on when various Metrolinx/TTC projects would actually open. Fall = second half of year. Some of these are wild guesses, others have more factual basis.
Line 10 Hurontario -Fall 2028 earliest, likely 2029 (early utility works 2017, 2020 construction start)
Line 5 Western Extension likely Fall 2033 earliest (2021 start)
Line 2 Extension to Sheppard McCowan likely Fall 2033 earliest, 2034 more likely. (2021 start)
Line 3 Ontario Line likely 2035 (2021/2022 start, but first TBM dig only started in 2026)
Line 1 Yonge North likely Fall 2035 earliest, assuming nothing goes wrong like in SSE. 12 years average from above would mean 2037+
Waterfront East LRT, Fall 2040 earliest
- From Spring 2023, we're now 3 years past that with little to no progress:
View attachment 736550
Unless you have taken a close look in person of things, follow various issues, you are pure guessing. You are a sidewalk supervisor with no background knowledge of construction, planning and etc.As the topic of Line 2 SSE being delayed til 2033 has made the news, I thought I'd post my predictions on when various Metrolinx/TTC projects would actually open. Fall = second half of year. Some of these are wild guesses, others have more factual basis.
Line 10 Hurontario -Fall 2028 earliest, likely 2029 (early utility works 2017, 2020 construction start)
Line 5 Western Extension likely Fall 2033 earliest (2021 start)
Line 2 Extension to Sheppard McCowan likely Fall 2033 earliest, 2034 more likely. (2021 start)
Line 3 Ontario Line likely 2035 (2021/2022 start, but first TBM dig only started in 2026)
Line 1 Yonge North likely Fall 2035 earliest, assuming nothing goes wrong like in SSE. 12 years average from above would mean 2037+
-----------------------------
Hamilton LRT, Fall 2035 or later. (14km)
Waterfront East LRT, Fall 2040 earliest
- 10km Line 6 FW took over 6 years from 2019 to 2025
- 18km Line 10 Hurontario will take 8+ years from 2020 to 2028
- “The [alliance] development phase will last 18-24 months” means construction will start in 2028
- "It is to be noted at this point that to allow each utility company to carry out individual re-locations of their plant within a cohesive and intense schedule will not be possible and will inevitably extend the construction period beyond 6 years." Source

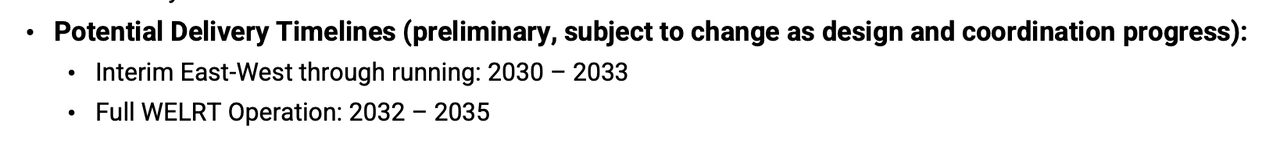

- From Spring 2023, we're now 3 years past that with little to no progress:
View attachment 736550
Line 7 Eglinton East, Fall 2040 Earliest, likely cancelled or changed.
Line 4 Sheppard Eastern extension to Sheppard and McCowan, Fall 2042 earliest
GO RER / Expansion Lakeshore West and Lakeshore East, 2040 earliest.

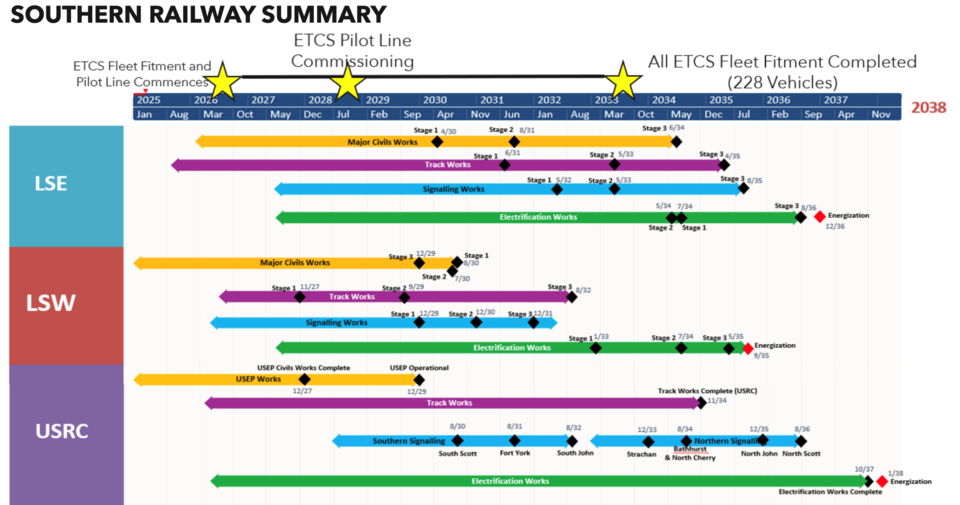

- January 2038 is the scheduled "energization" according to the Metrolinx calendar, tack on 1 year of testing and commissioning, and convert to the Gregorian calendar, and we're easily at 2040.
View attachment 736559
I have largely agreed with you on this before, my push back being that you never know what unforeseen circumstances pop up. I did not mention Line 5 Eglinton's issues, but now that you bring it up, much of what delayed Eglinton was the CBTC / "signalling". Hurontario uses a Hitachi CBTC system.I know for a fact that Hurontario LRT will open in 2028 as the major construction will be completed by year end.
Is this something we know for sure, or just speculation? Also, the consortia members are (somewhat) different for each project?ML has learn a lesson from Line 6 and Hurontario problems.
He said these are his predictions? Why so rude to point out that predictions is guessing?Unless you have taken a close look in person of things, follow various issues, you are pure guessing. You are a sidewalk supervisor with no background knowledge of construction, planning and etc.[
...... The criteria that the Ontario line has to open before YNSE (Line 1) ends the day it becomes politically expedient for the Premier of Ontario to open YNSE first.
No, it does not.
Line 1 will not have sufficient capacity to carry the extra load w/o the Ontario Line in place.
Because a leader has never ordered something be done despite the consequences? Even when everyone around them sees immediate problematic consequences of a decision?
It doesn't. But it does have sufficient capacity for everyone in possible flip-riding north of Steeles to board - and even get a seat.No, it does not.
Line 1 will not have sufficient capacity to carry the extra load w/o the Ontario Line in place.
It very probably (99.9%) won't. And it shouldn't. But I don't know what a track record has to do with anything about predicting what a moron at Queens Park might do - or contract that they may rip up at huge expense.You can believe what you wish. My track record speaks for itself. It will not open first.
